Skip to content

Magical Revolving Lantern

My Fab Academy 2025 final project involves developing a Magical Lantern that combines traditional Chinese lantern aesthetics with modern digital manufacturing technology. You can learn about the initial concept and development process through the following links:

Core Functions:

  • Using a motor to drive the lampshade rotation, replacing traditional hot air flow drive
  • LED array replacing traditional candles, providing programmable lighting effects
  • Intuitive human-machine interaction through gesture sensors
  • Remote control functionality via WiFi connection

Project Progress

WeekDatePlanned ContentStatusDocumentation Link
Week 1Jan 22Final Project Conceptualization and Requirements Analysis✅ CompletedProject Concept Details
Week 2Jan 29Lantern Shell 3D Modeling and Design✅ Completed3D Modeling Process
Week 3Feb 5Lantern Shell Laser Cutting and Assembly✅ CompletedLaser Cutting Implementation
Week 6Feb 26Control Circuit PCB Design✅ CompletedCircuit Design Process
Week 8Mar 12PCB Circuit Board Production✅ CompletedCircuit Board Production
Week 9Mar 19Gesture Sensor Integration✅ CompletedGesture Control Implementation
Week 10Mar 26Output Device Control (Fan Motor and LED)✅ CompletedOutput Control System
Week 11Apr 2Dual-Node Gesture Control✅ CompletedDual-Node Gesture Control
Week 15May 6Web Control Interface Design and Implementation✅ CompletedWeb Control Interface Design and Implementation
Weeks 13-15May 10Rotating Structure Mechanical Design✅ CompletedMotion Mechanism Design
Week 16May 7-14System Integration✅ CompletedSystem Integration Design
Week 17May 15-21Final Solution PCB Design and Program Debugging📅 Planned-
Week 18May 22-27Final Solution Structure Refinement and Testing📅 Planned
Week 19May 28-Jun 4Documentation Organization and Presentation Preparation📅 Planned-
Jun 9-13-Final Project Presentation📅 Planned-

Week 1: Final Project Concept

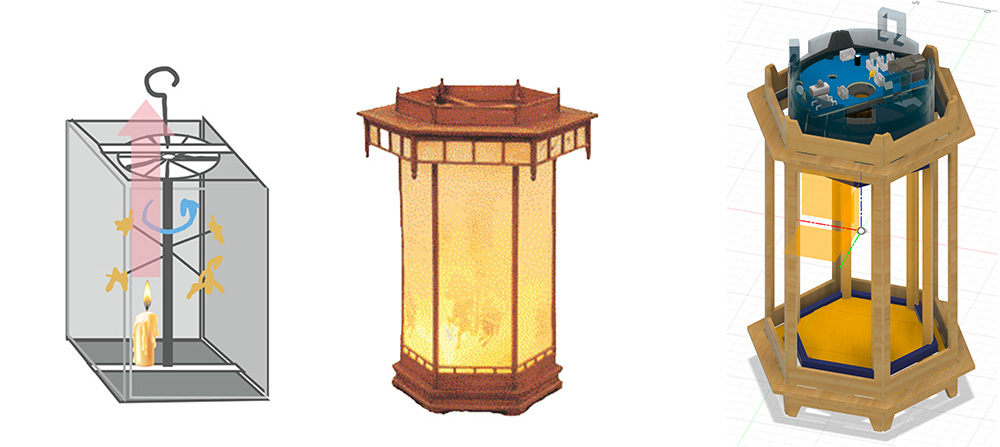

Completed the preliminary concept of the Magical Lantern project, determining the core functions and technical approach.

Week 2: 3D Modeling of the Magical Lantern

Used Fusion 360 to complete the 3D modeling design of the lantern shell, preparing for subsequent laser cutting.

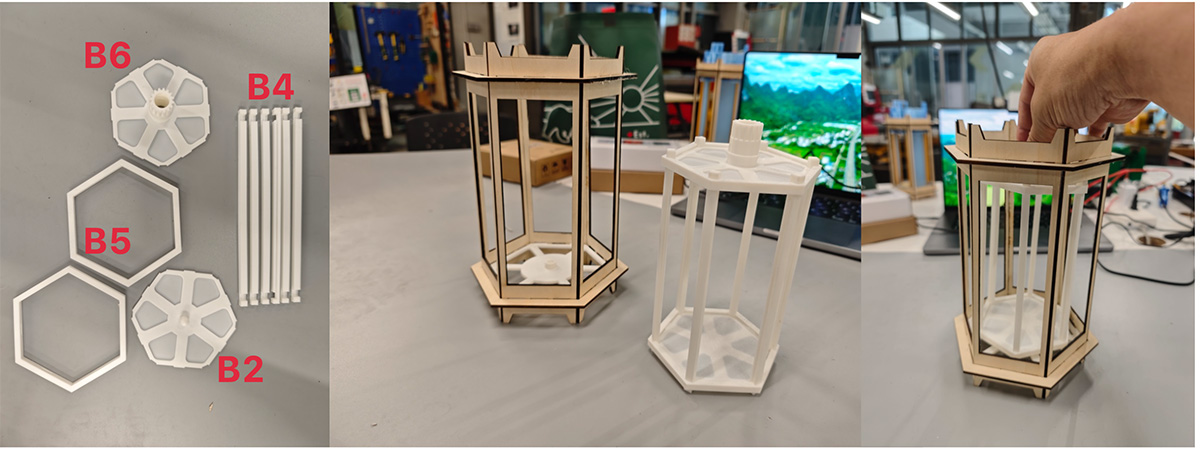

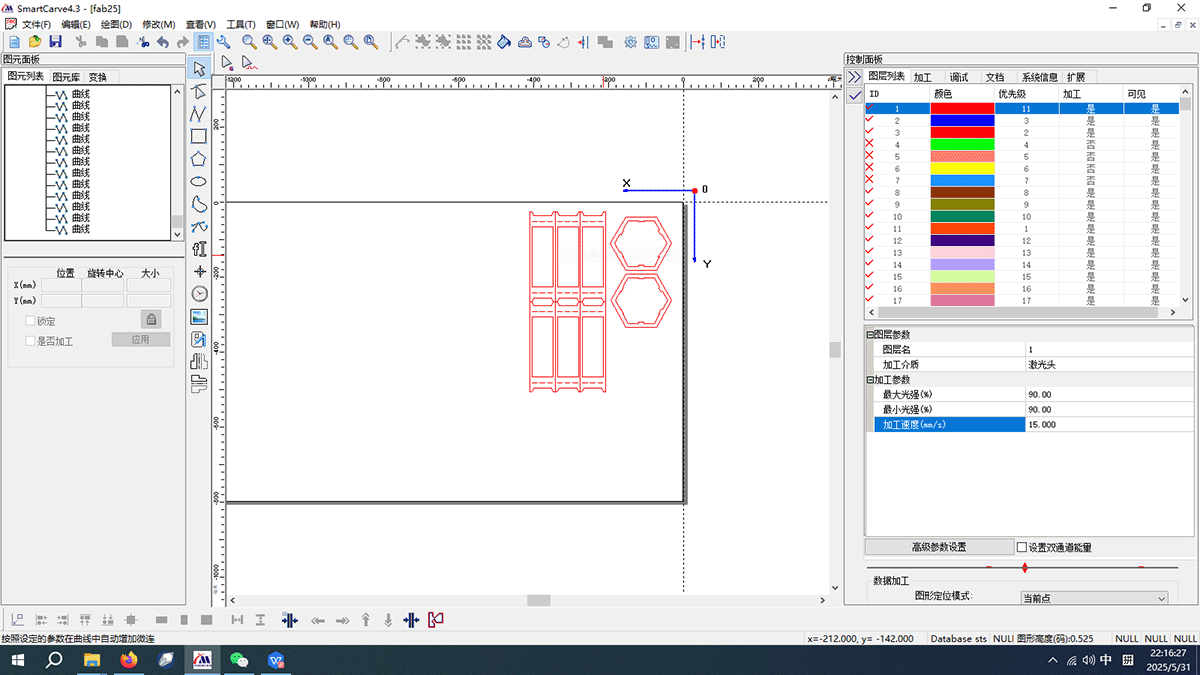

Week 3: Laser Cutting the Lantern Shell

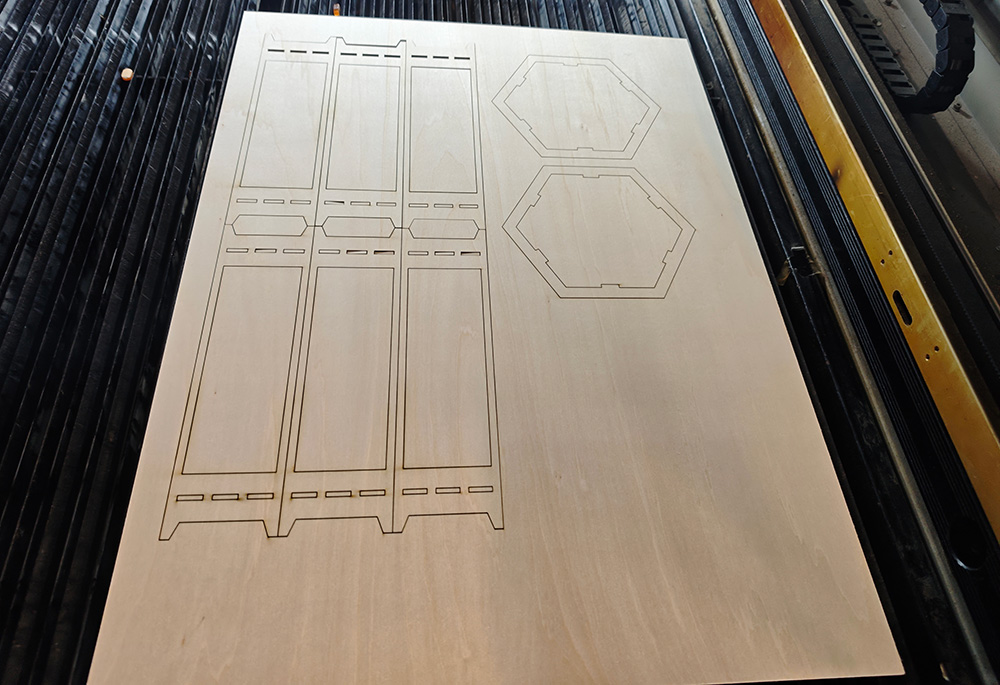

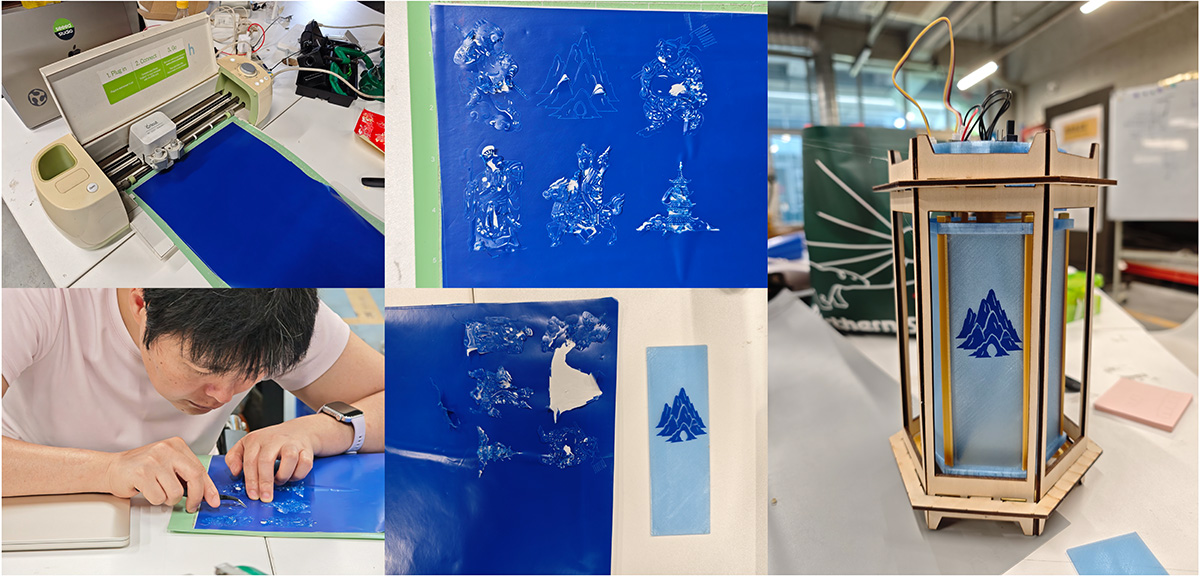

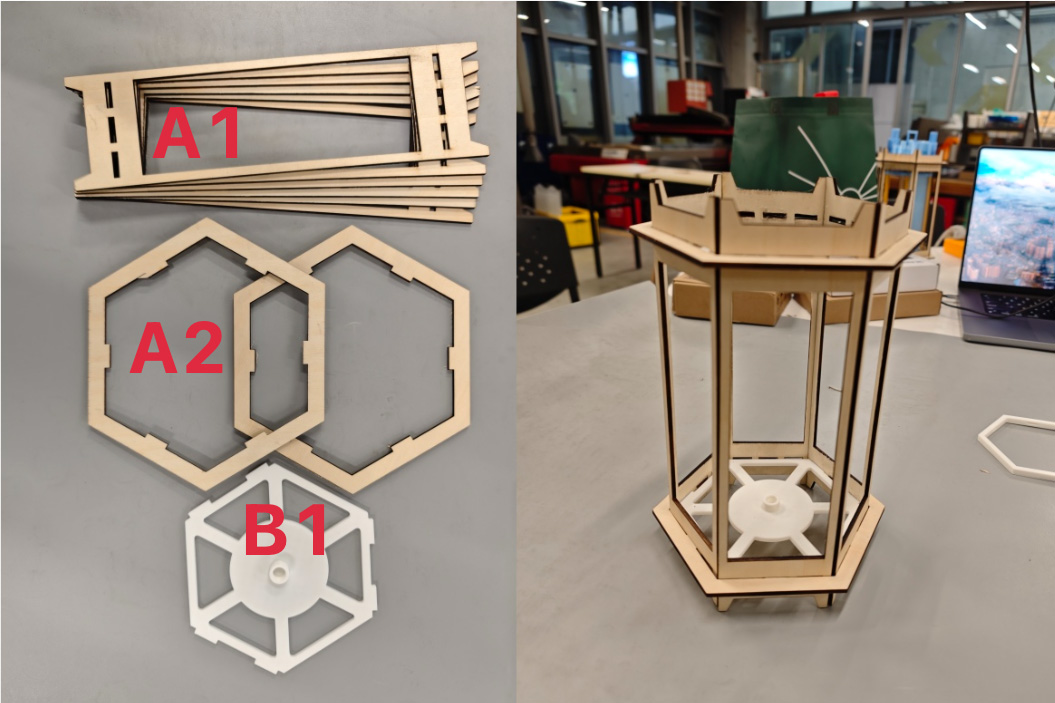

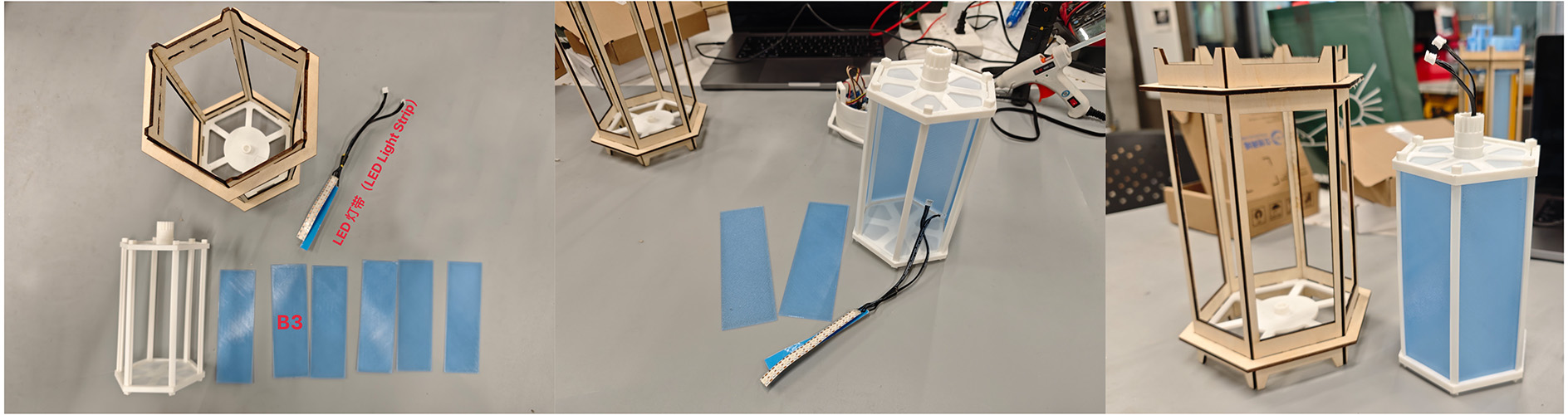

Successfully laser cut and assembled the hexagonal wooden lantern shell, verifying the feasibility of the design.

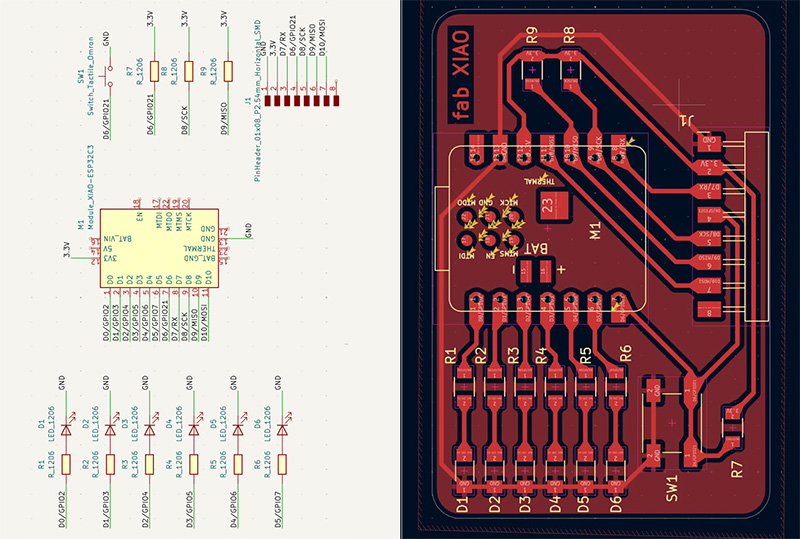

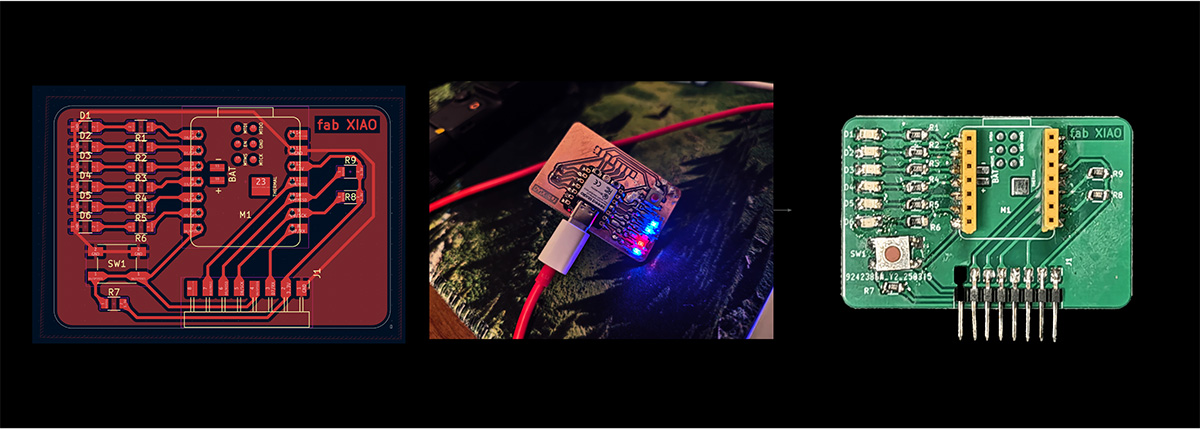

Week 6: Control Circuit PCB Design

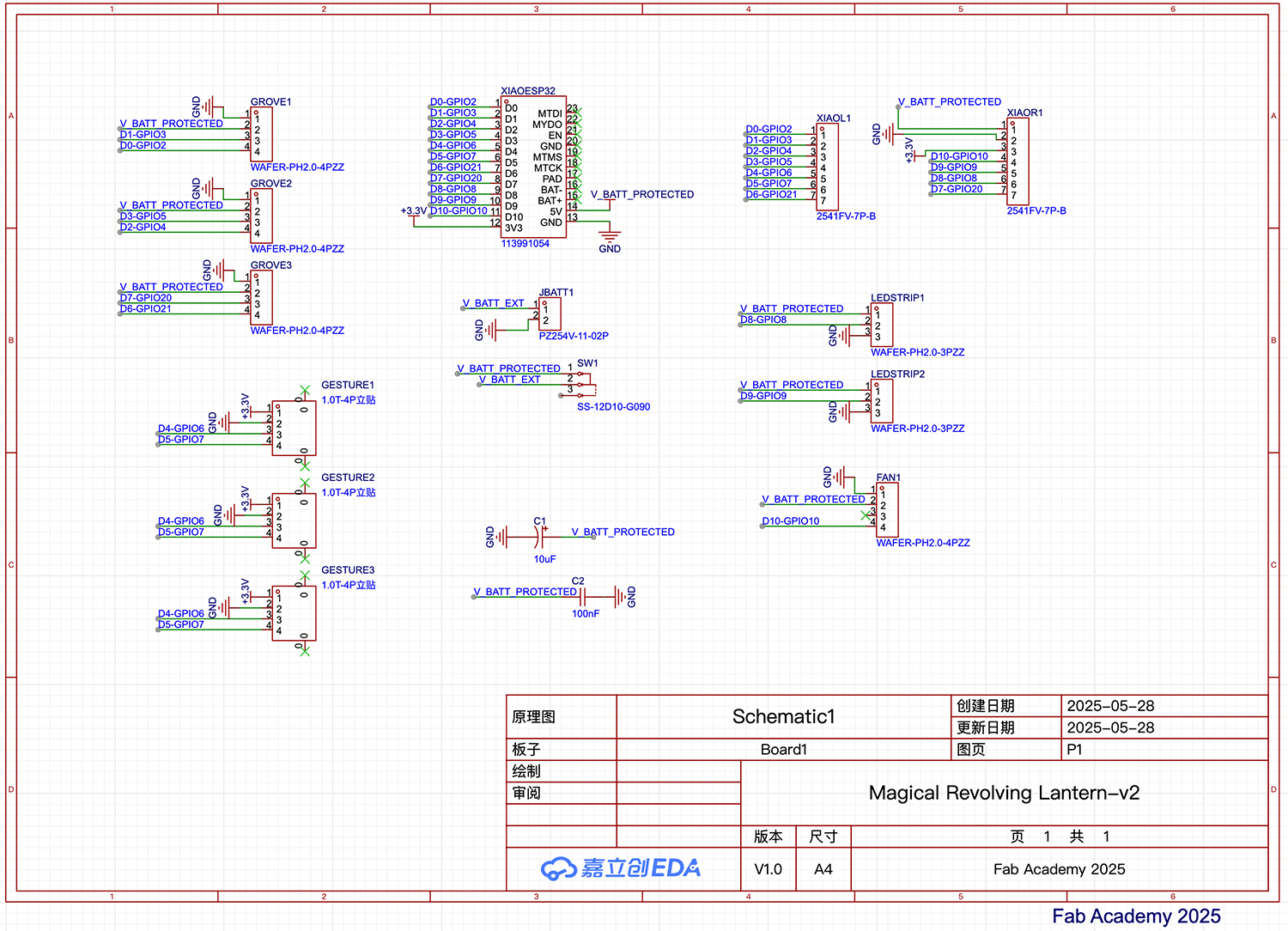

Designed an ESP32C3-based control circuit PCB, integrating gesture sensors and output control interfaces.

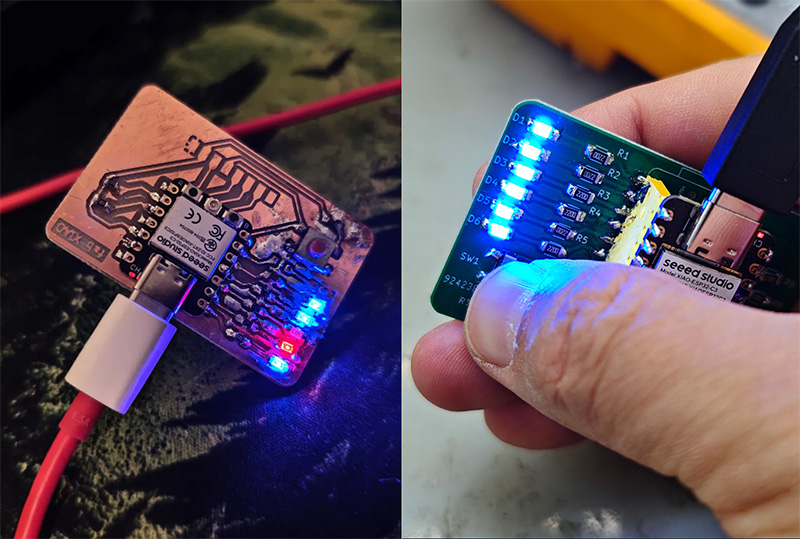

Week 8: Circuit Board Production

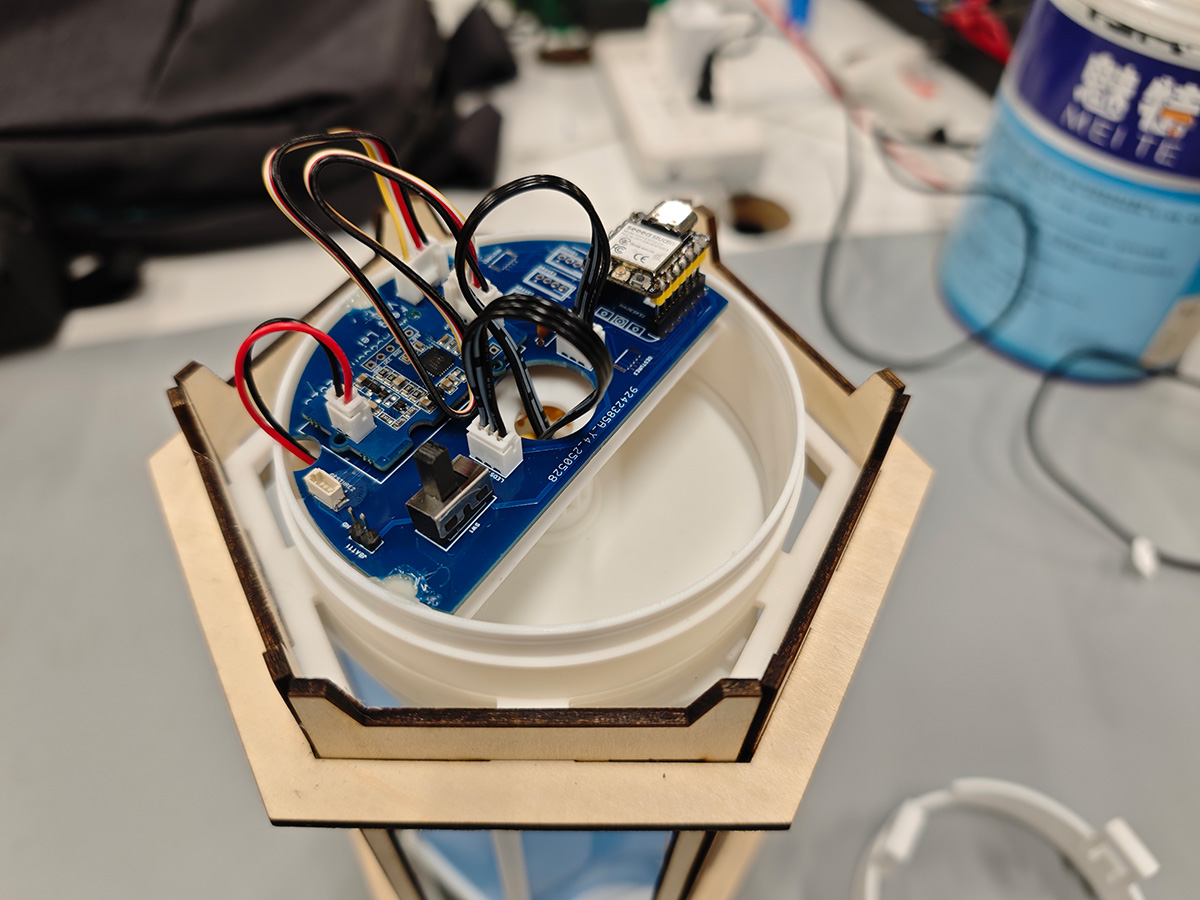

Successfully produced the control circuit PCB using a CNC mill, and completed component soldering and basic testing.

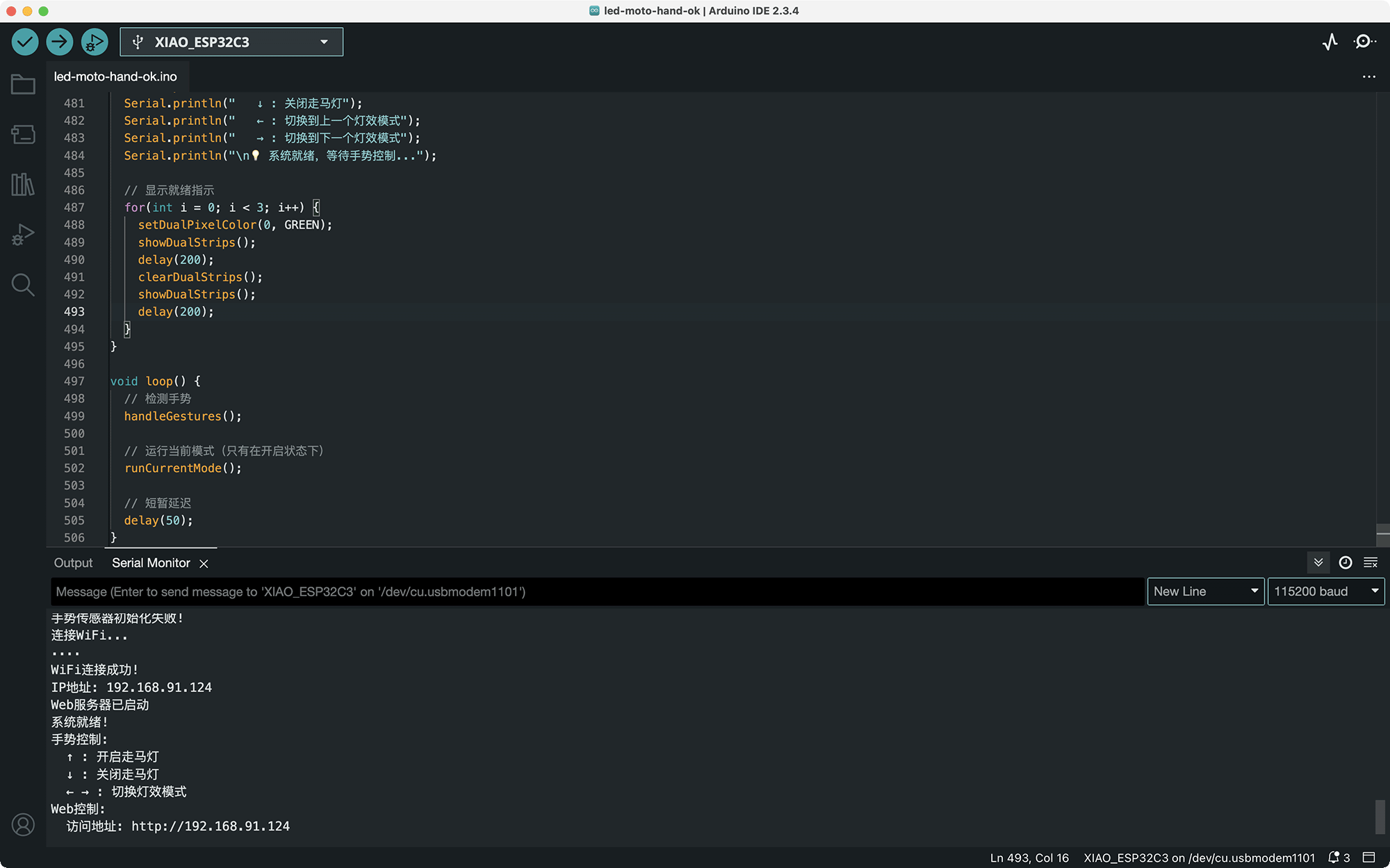

Week 9: Gesture Control Implementation

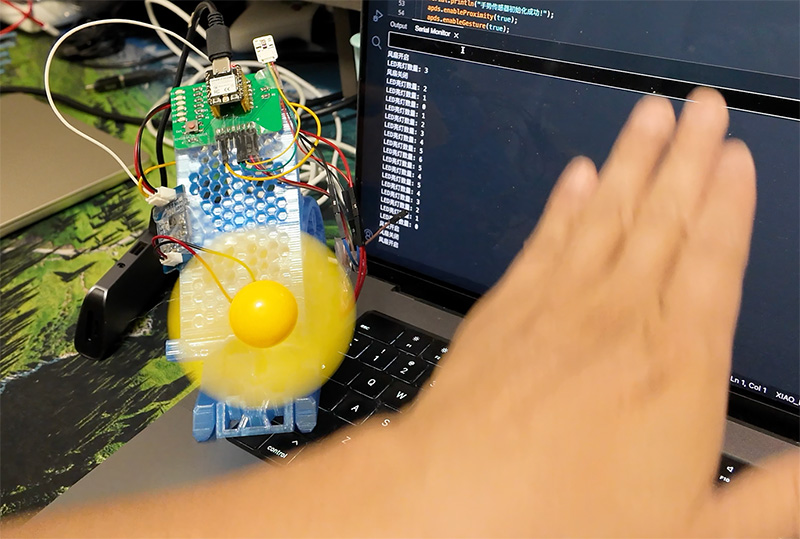

Implemented the integration of the APDS-9960 gesture sensor, successfully recognizing gestures in four directions: up, down, left, and right.

Week 10: Output Control System

Completed the drive control of the motor and LED light strips, achieving interactive effects between gestures and output devices.

Week 11: Dual-Node Gesture Control

Developed a dual-node communication system based on the ESP-NOW protocol, enabling gesture information transmission and synchronized control between multiple devices.

Week 15: Web Control Interface Design and Implementation

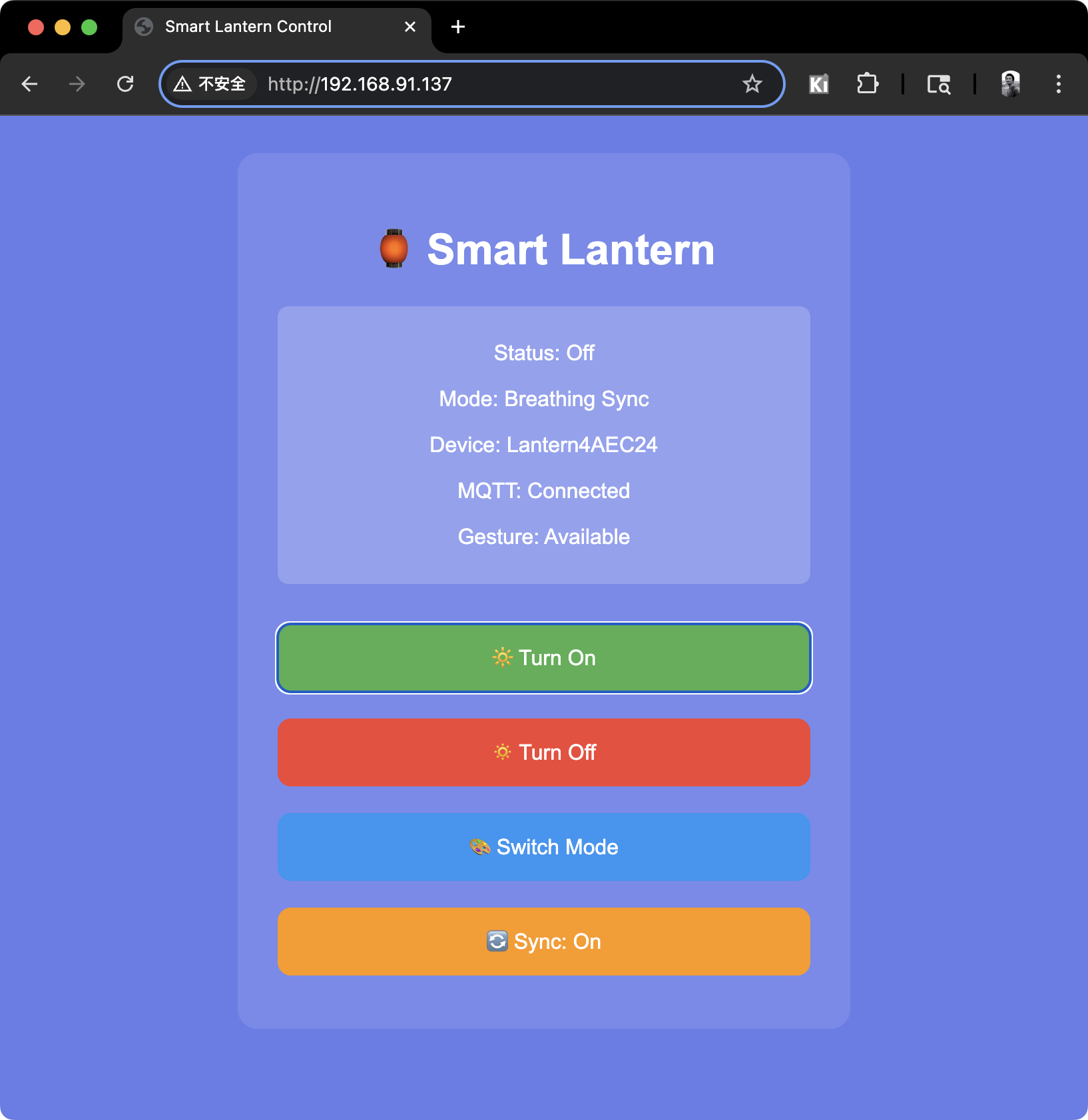

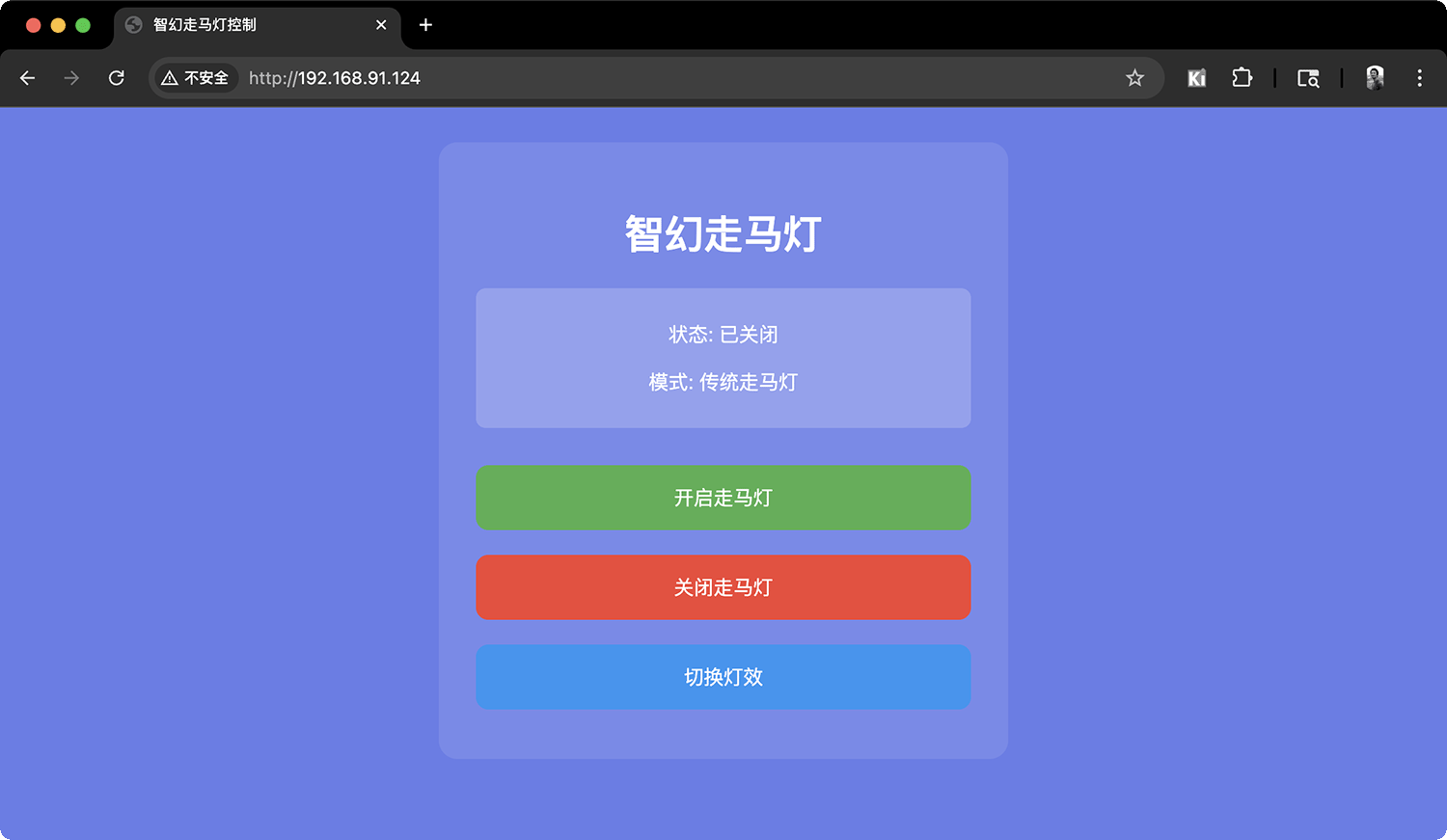

Designed and implemented a responsive web control interface, supporting remote adjustment of lighting effects and motor switches.

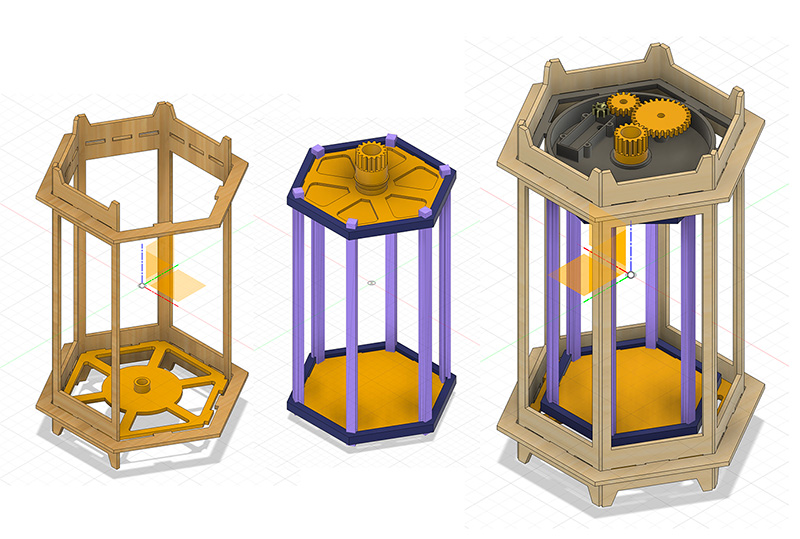

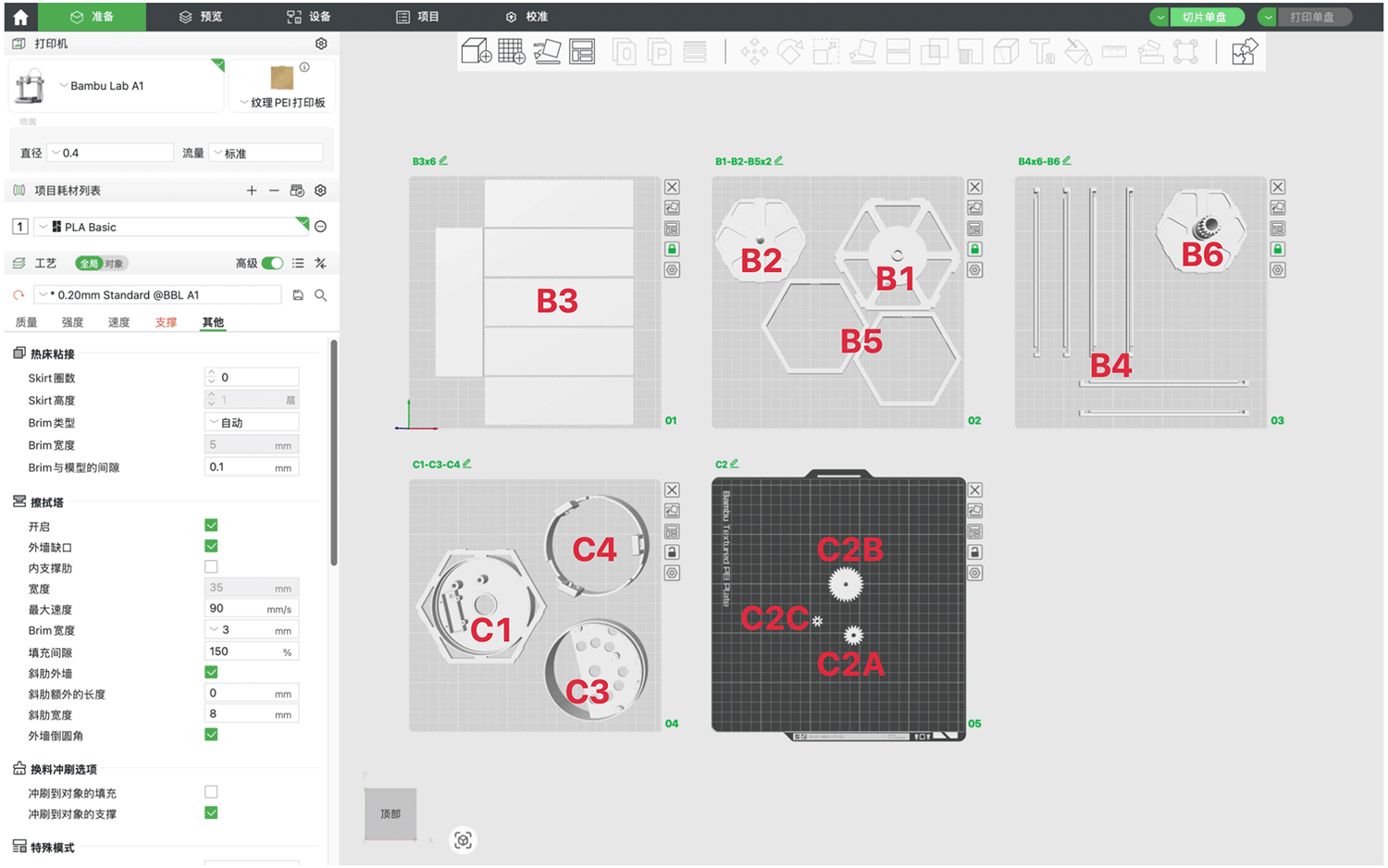

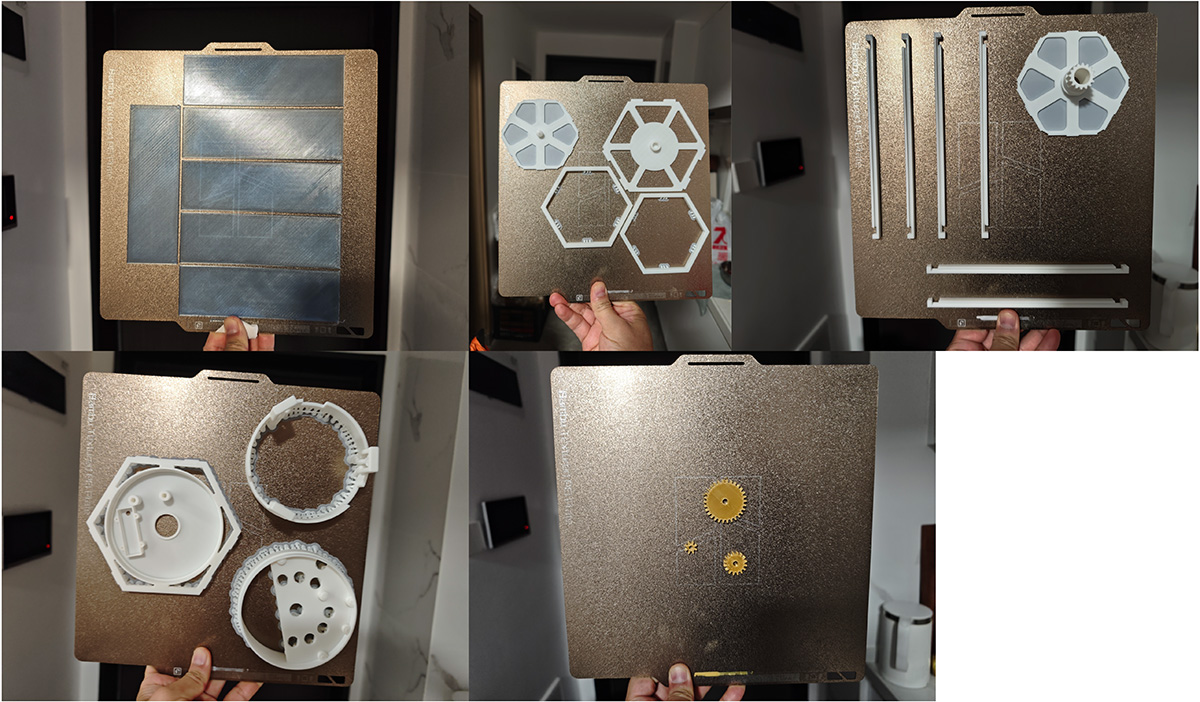

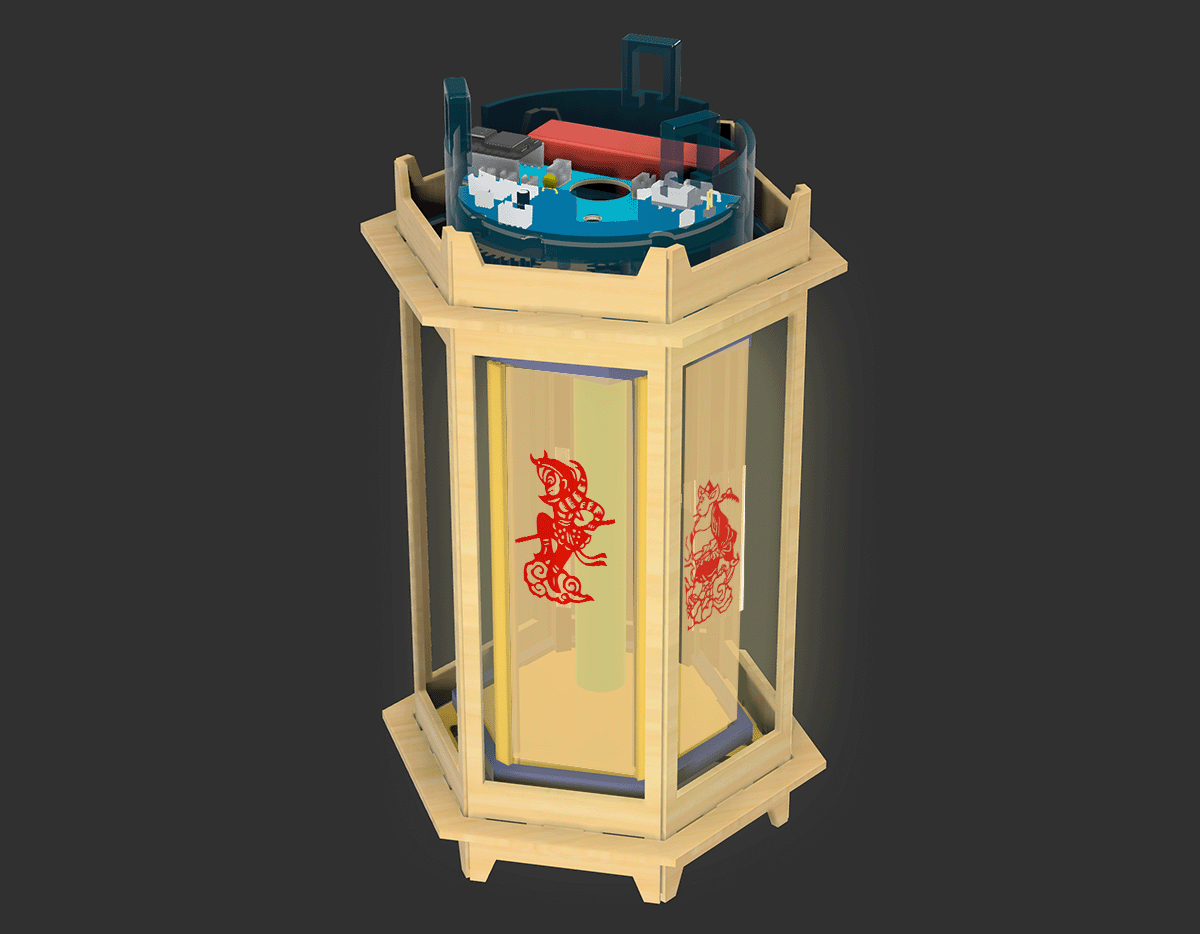

Week 15: Motion Mechanism Design

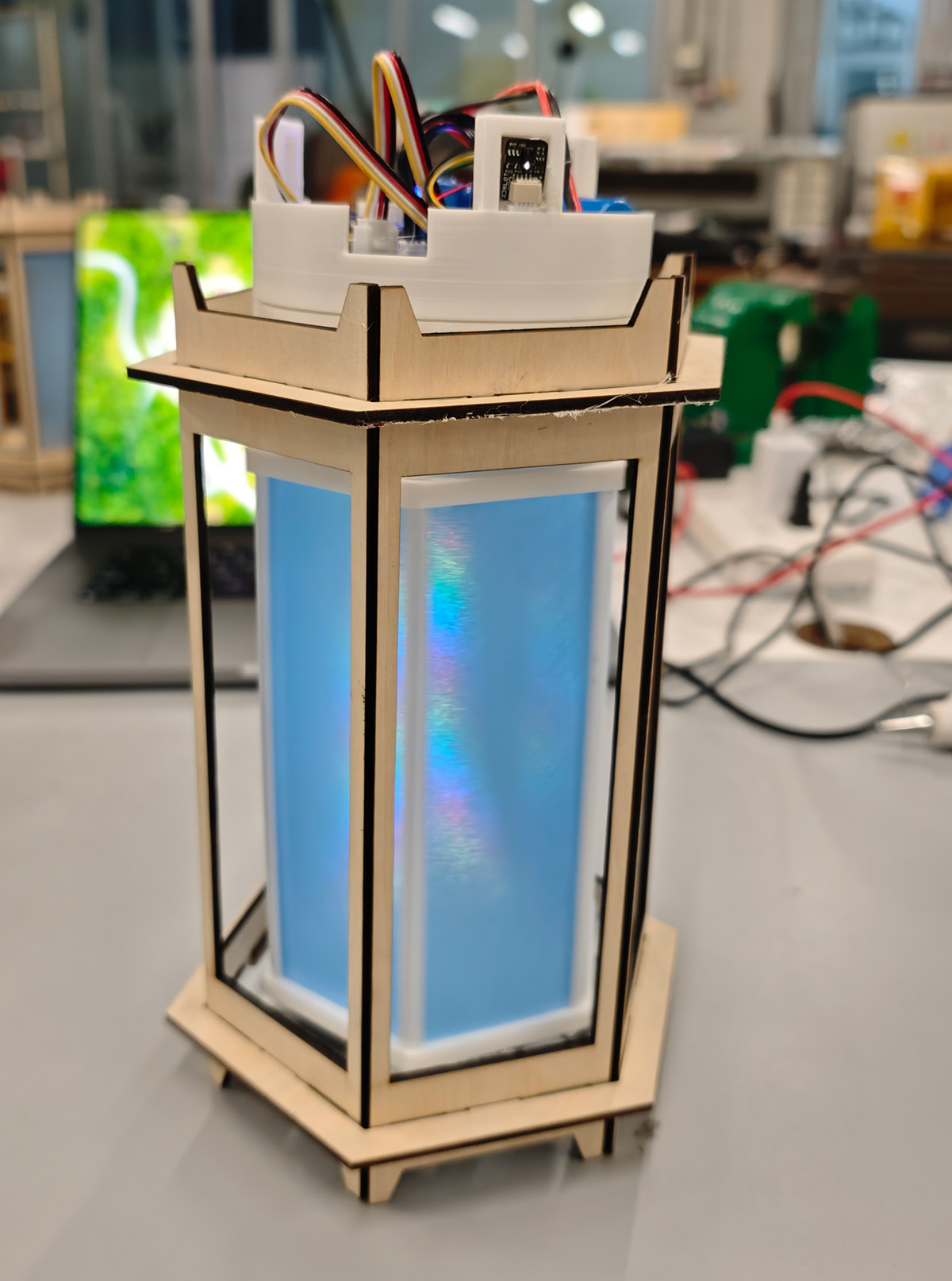

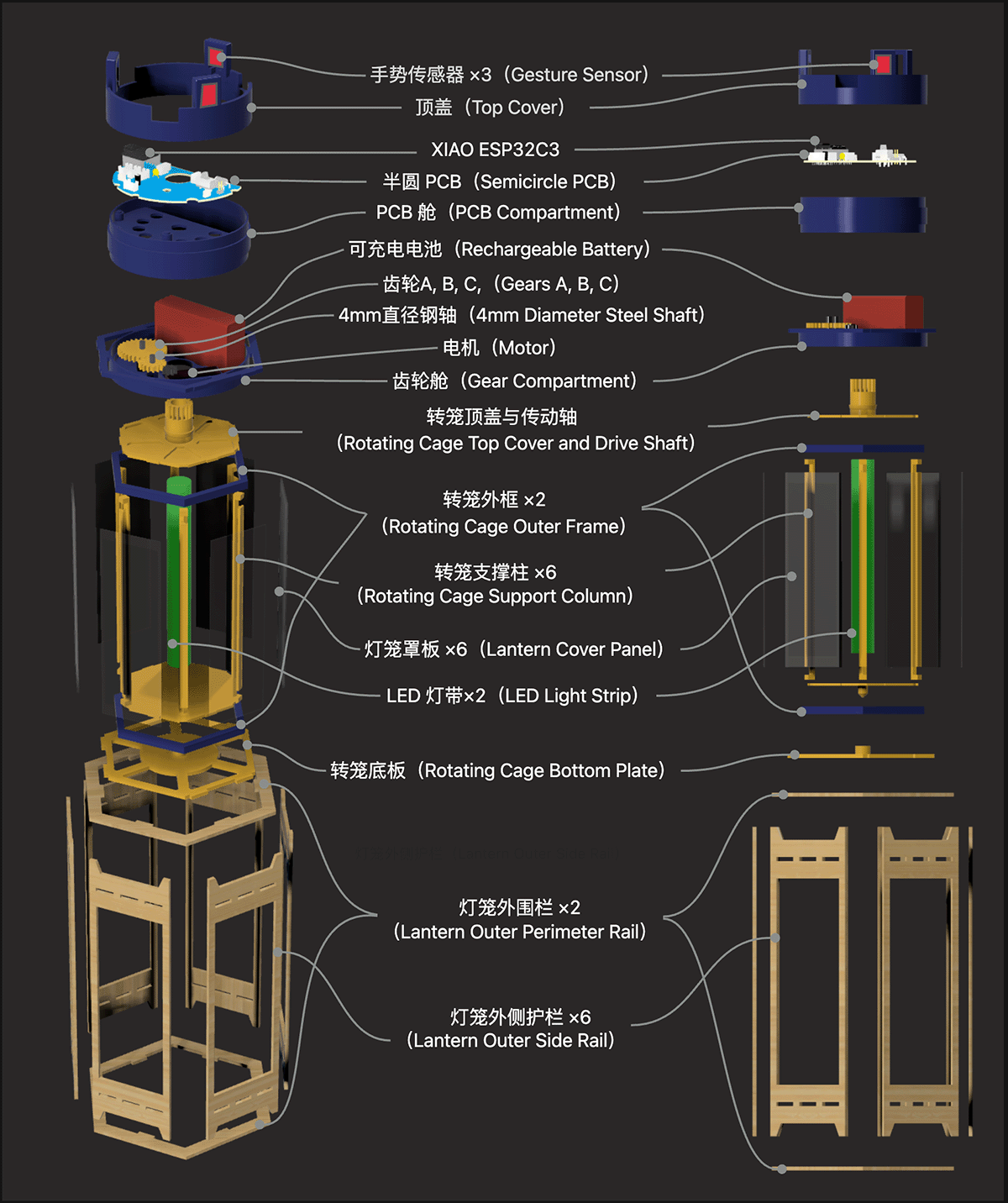

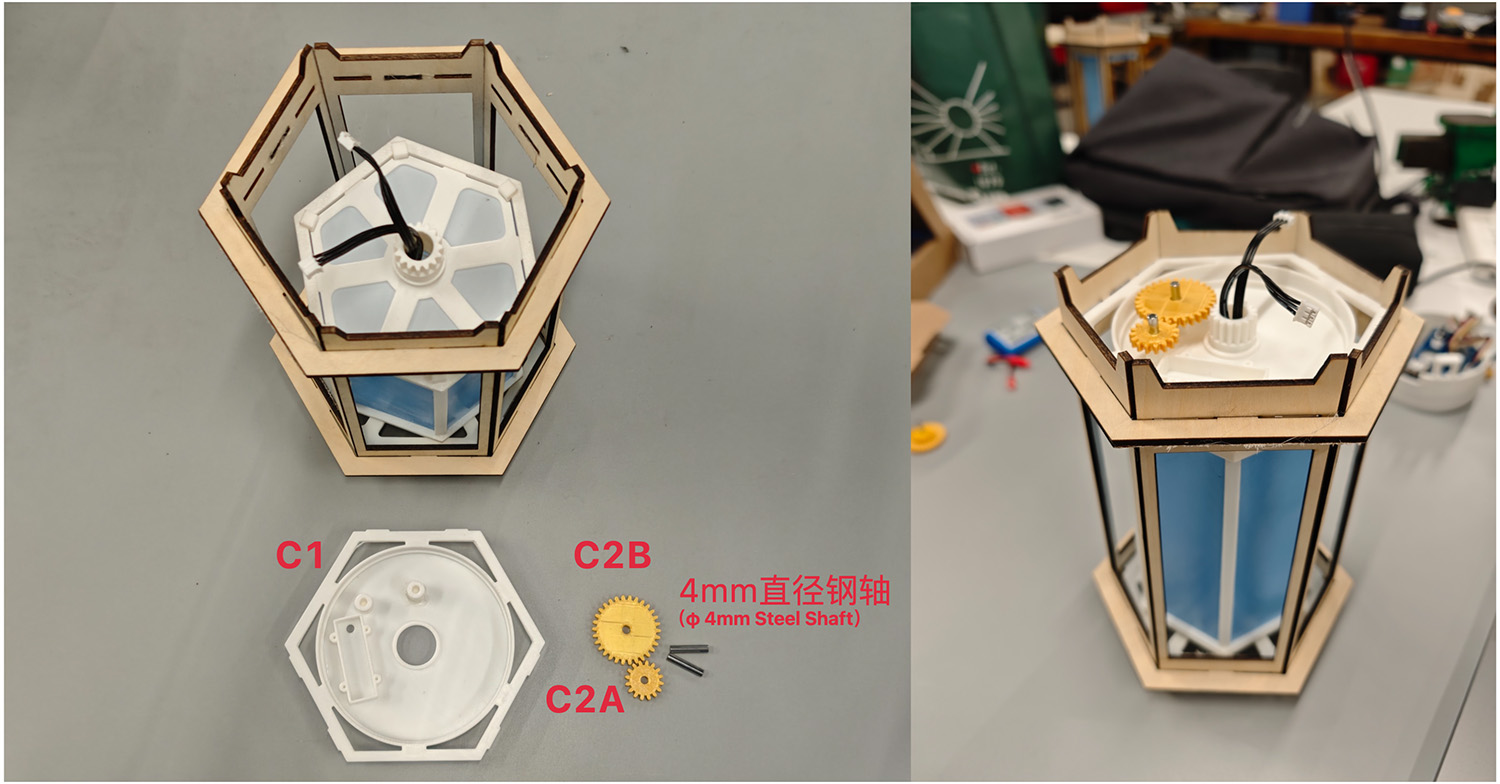

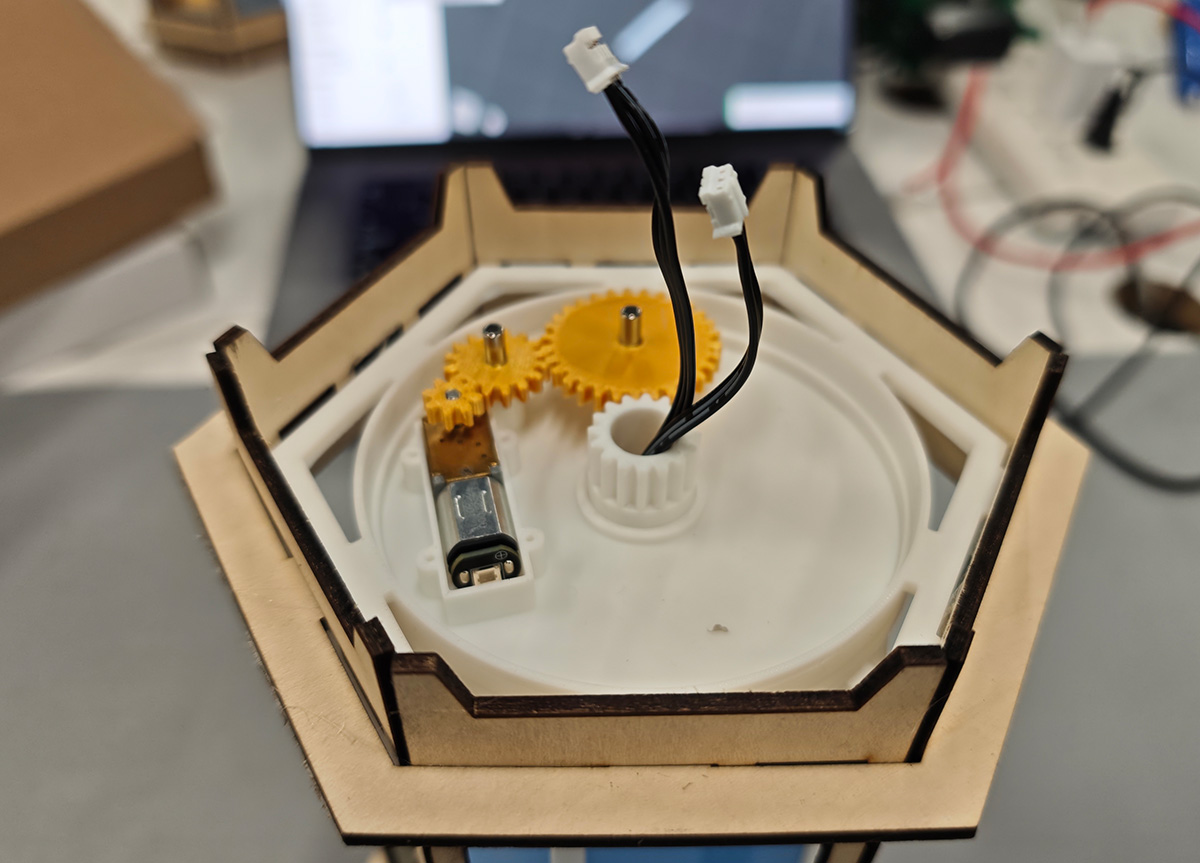

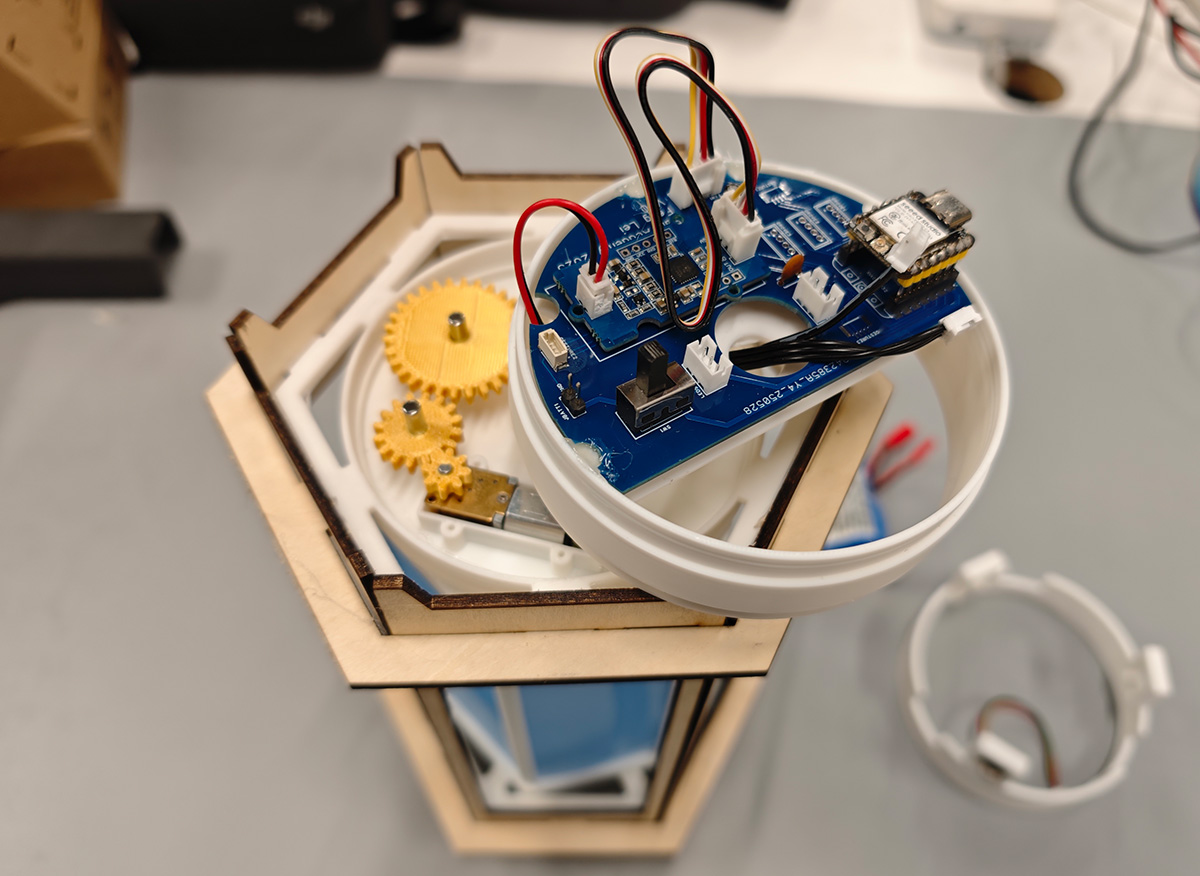

Designed and 3D printed the rotating cage mechanism and gear system, solving transmission and stability issues.

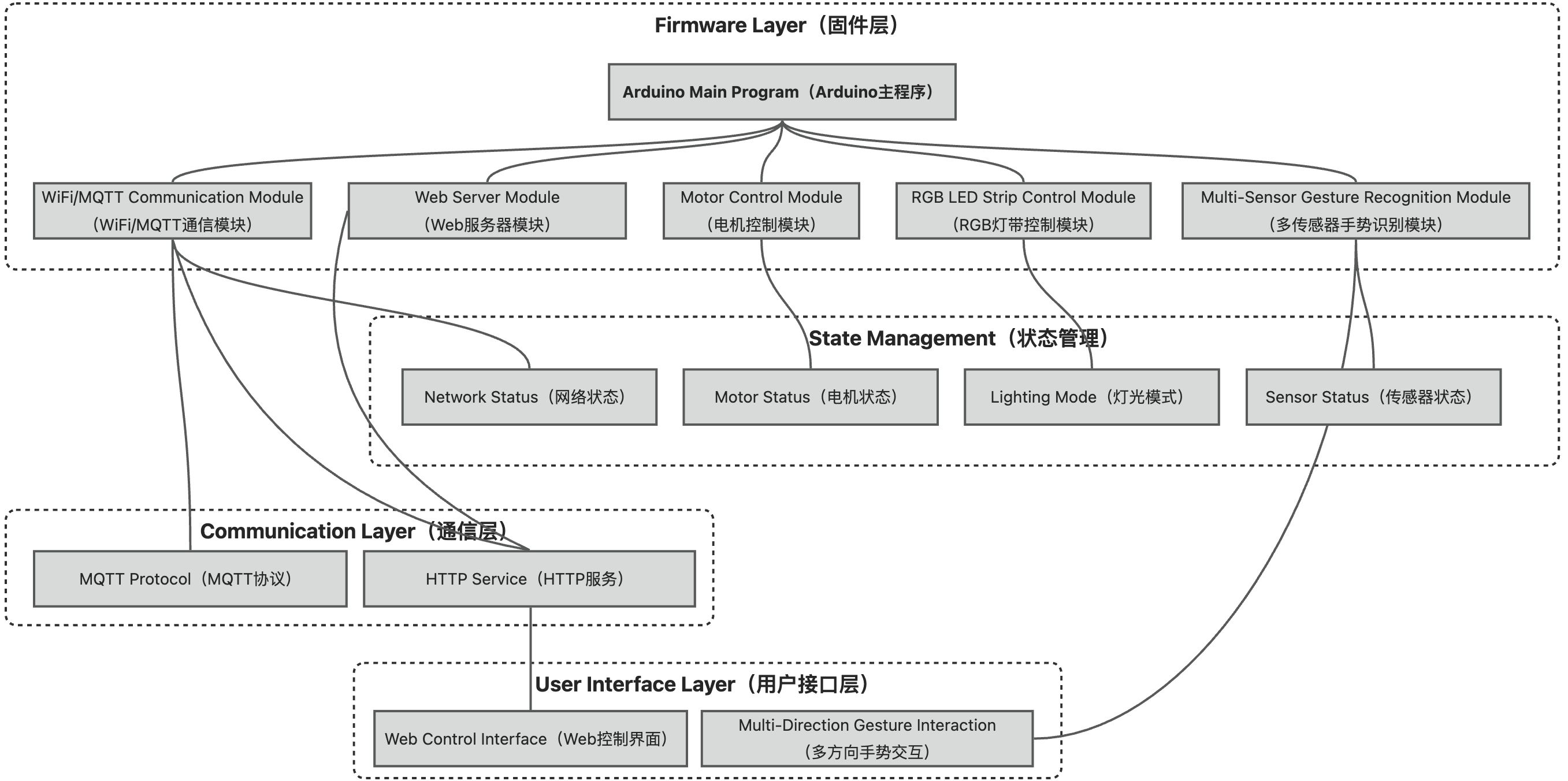

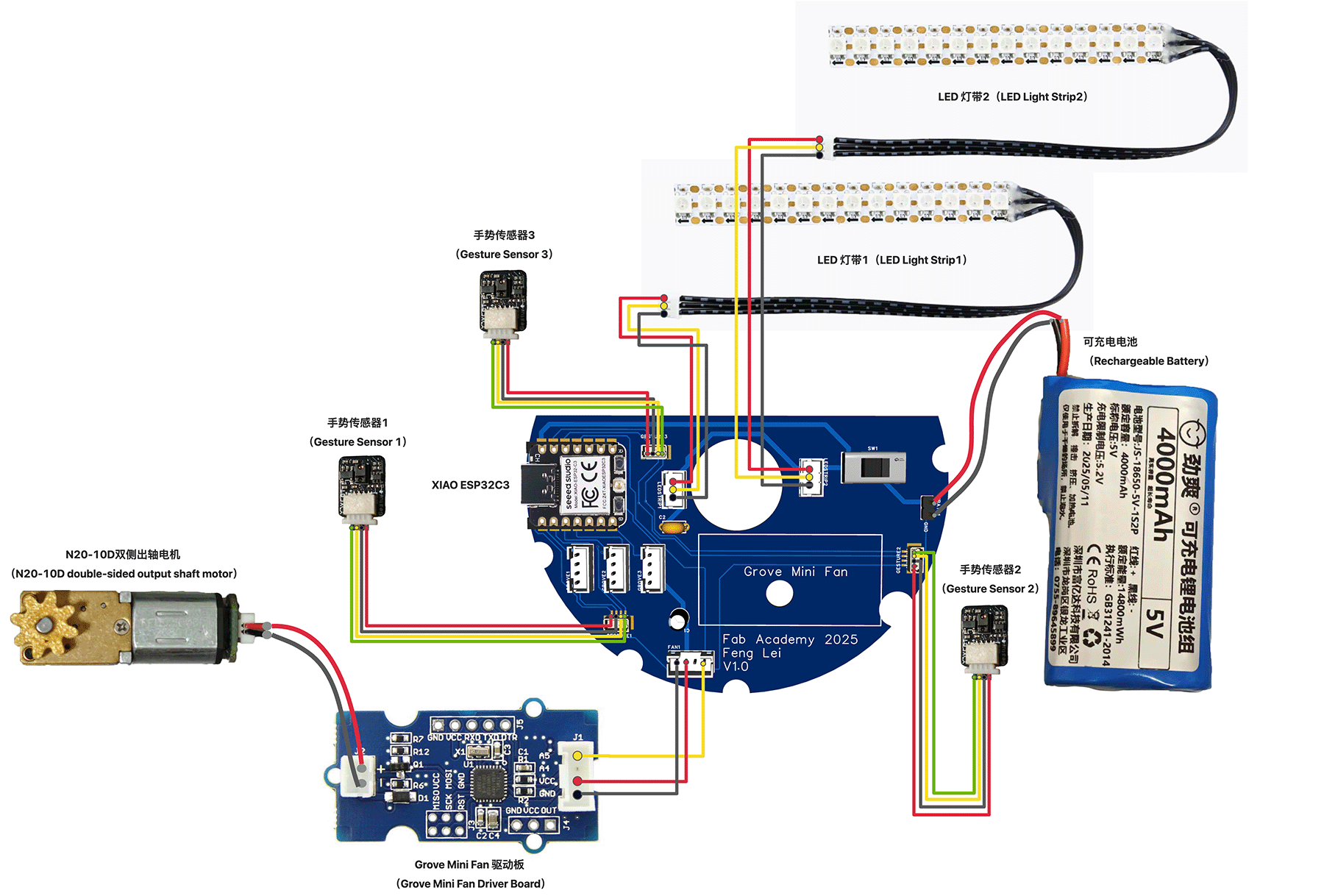

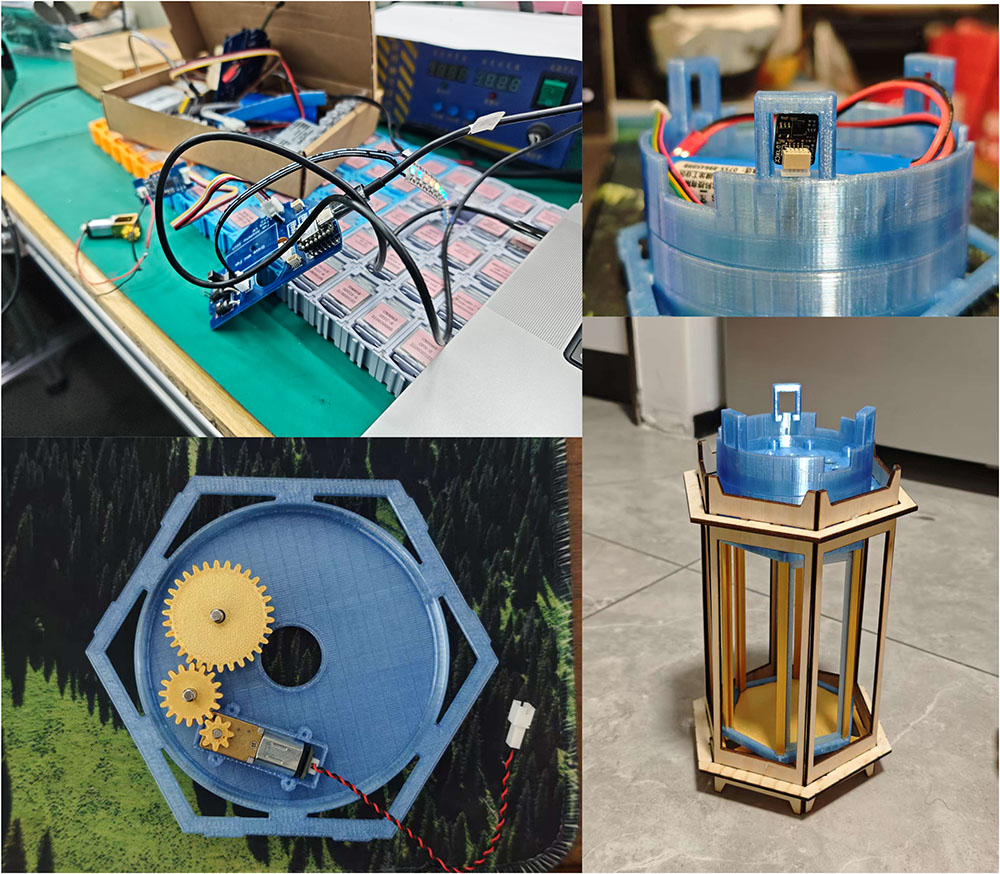

Week 16: System Integration Design

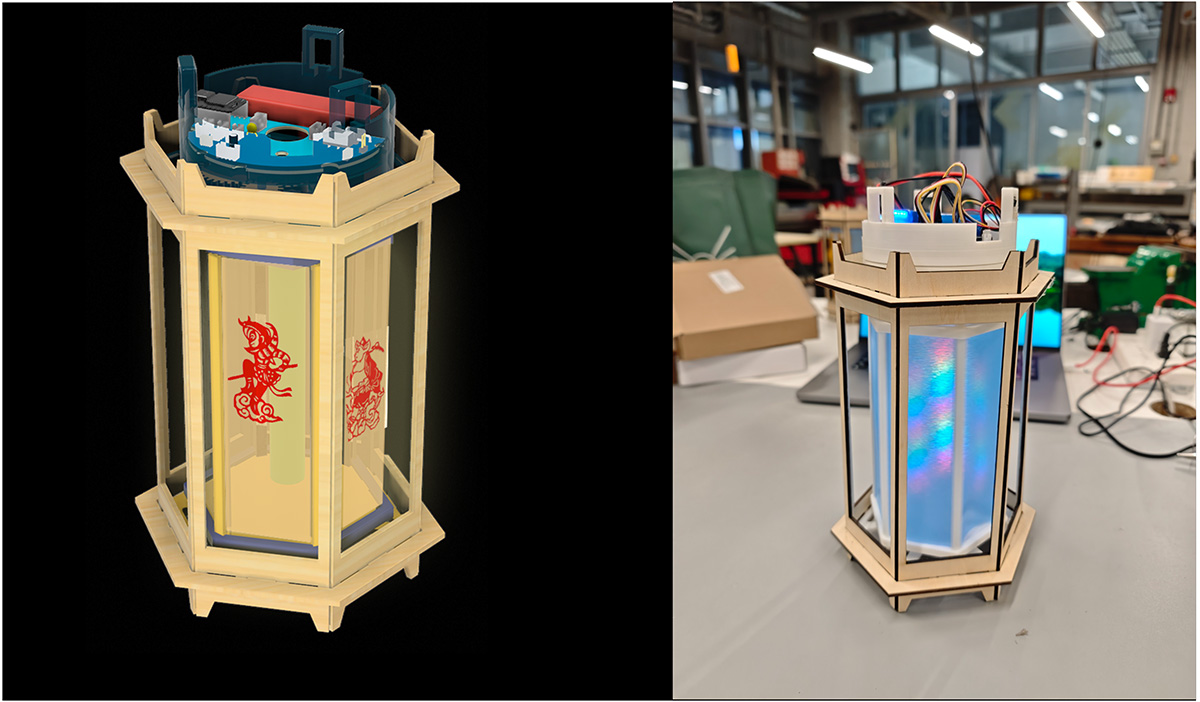

Redesigned the system architecture, integrating mechanical, electronic, and software subsystems, laying the foundation for the final product.

Solved and Unsolved Problems

Solved Problems

  • Lantern Shell Design and Fabrication: Successfully designed and laser-cut the hexagonal wooden shell in Week 3
  • Rotating Cage Mechanism Design: Designed and 3D printed a reliable rotating cage structure with proper tolerances

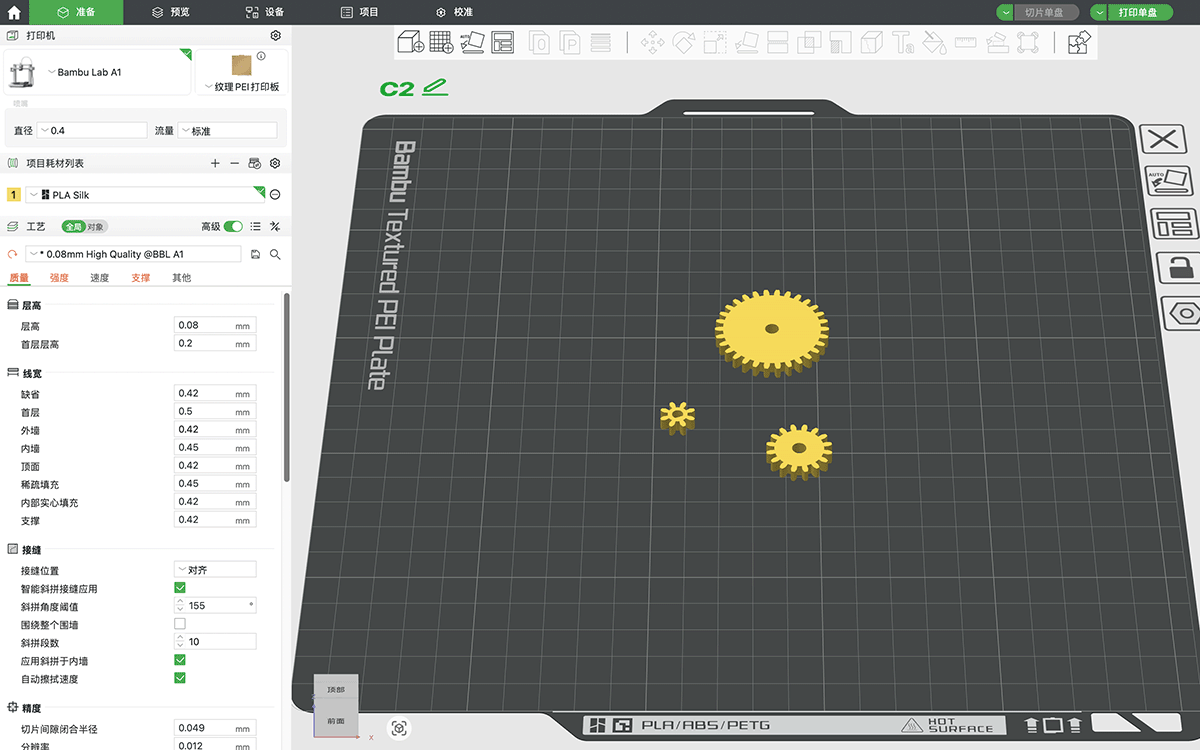

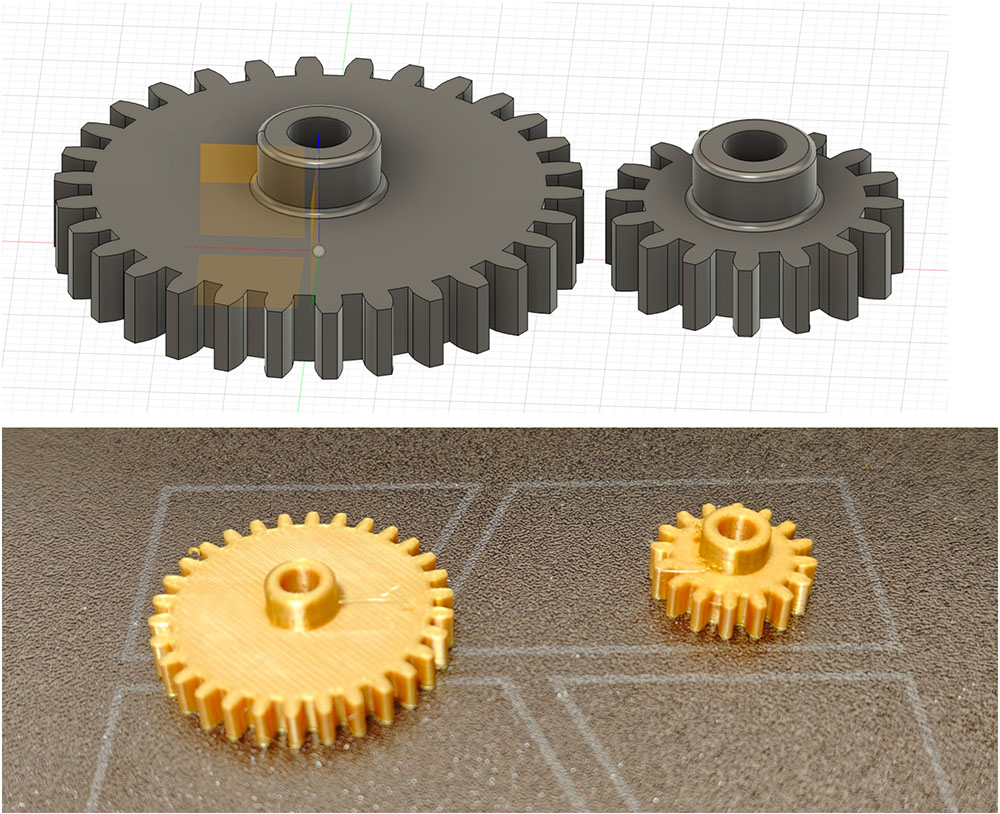

  • Gear System Implementation: Calculated appropriate gear module (1.11mm) and designed a functional gear system with steel shafts

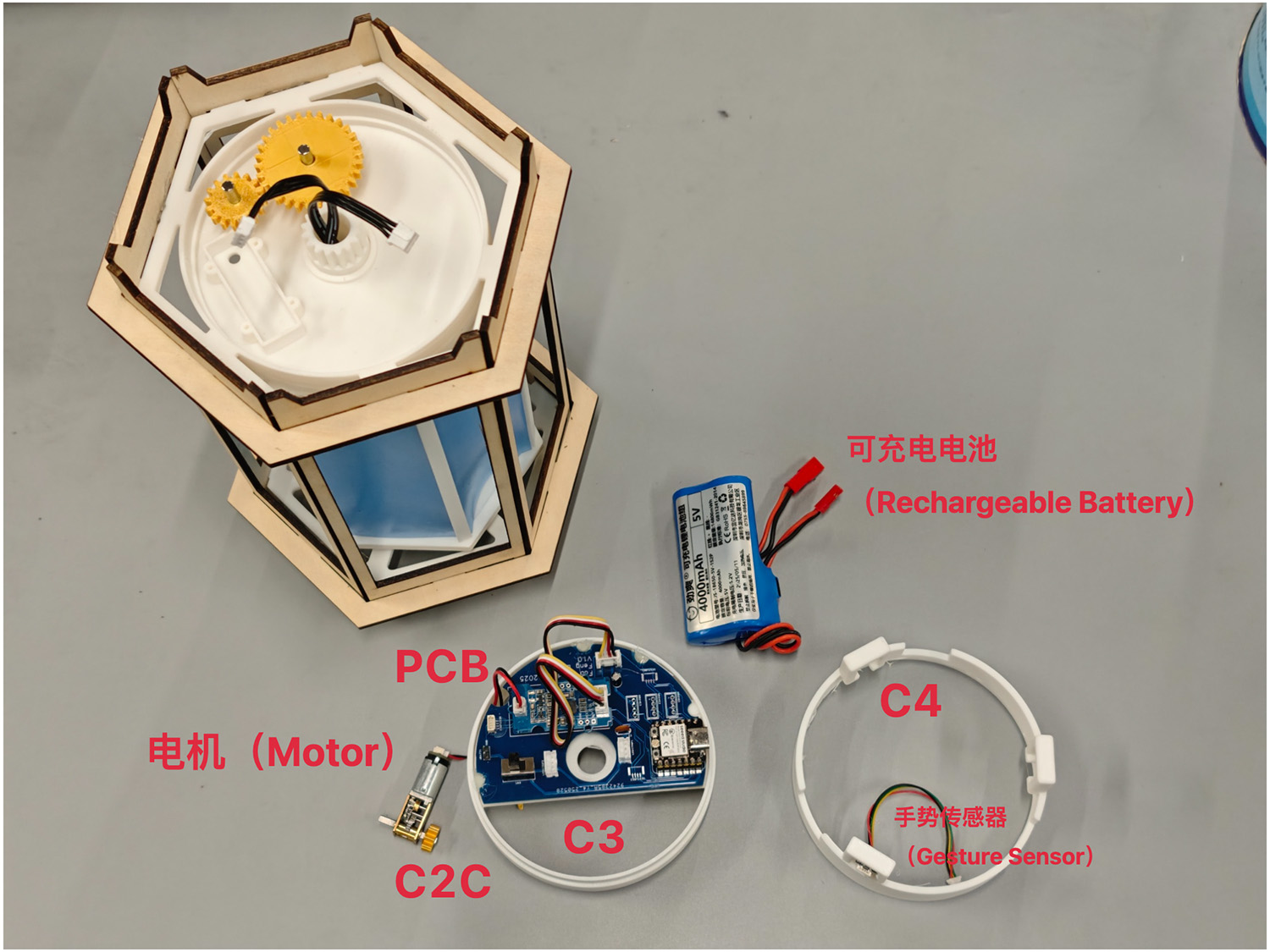

  • Motor Selection and Integration: Selected appropriate N20 dual-shaft worm gear motor (130rpm) with sufficient torque for the rotating mechanism
  • System Architecture Redesign: Completely revised the system architecture to address limitations in the original design

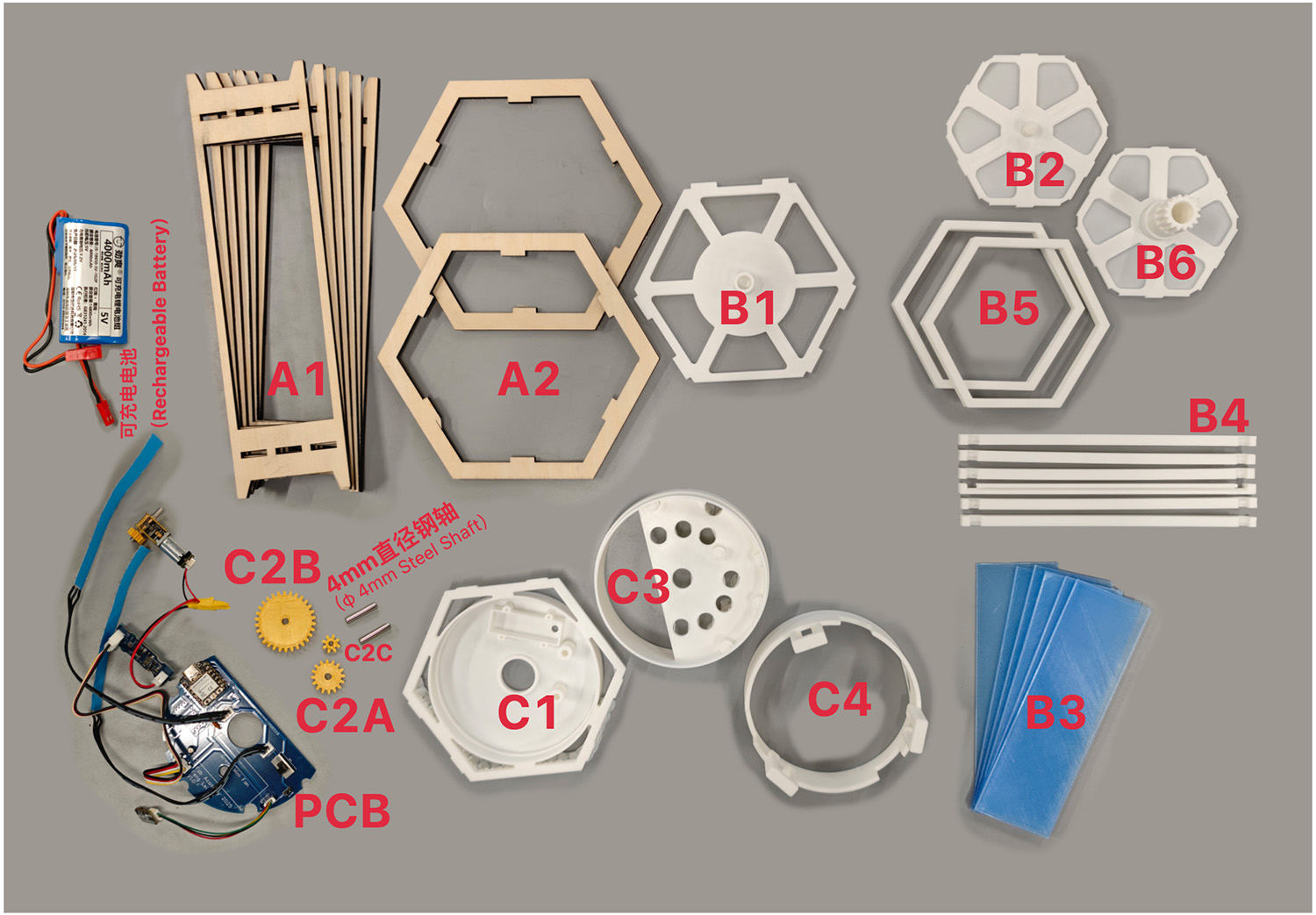

  • Component Selection and Sourcing: Identified and acquired all necessary electronic components for the improved design

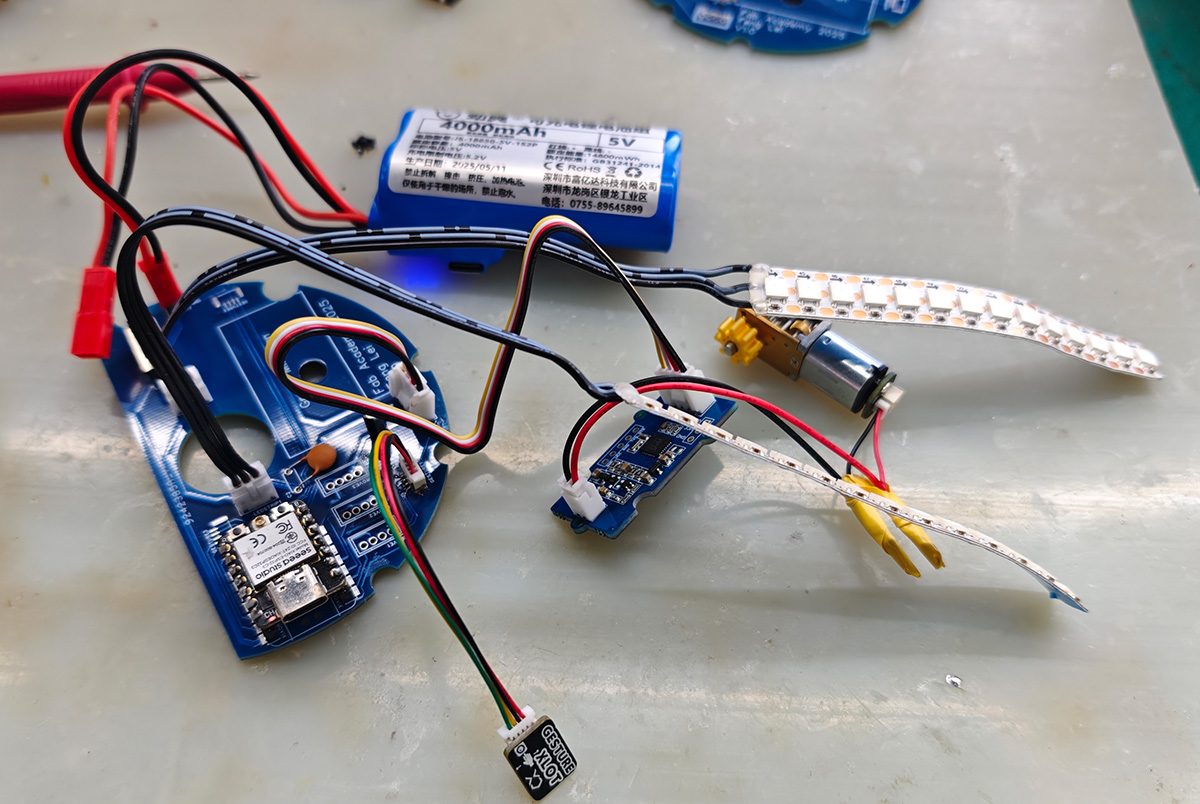

Unsolved Problems

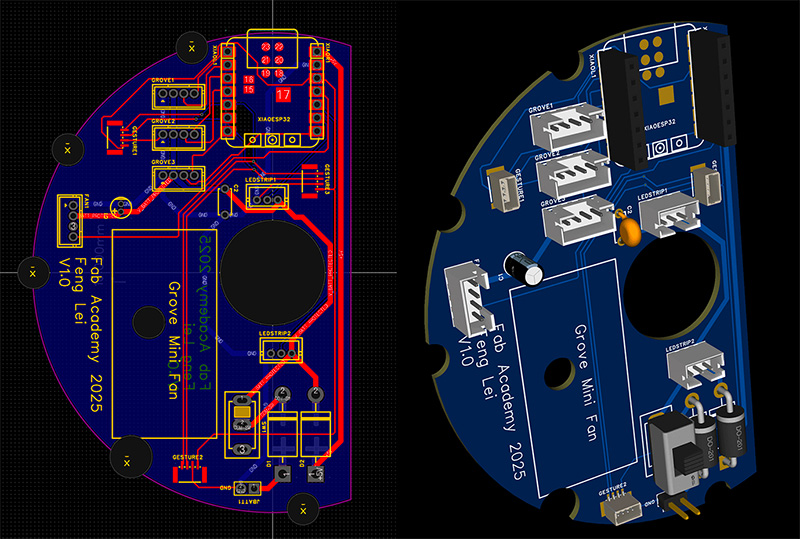

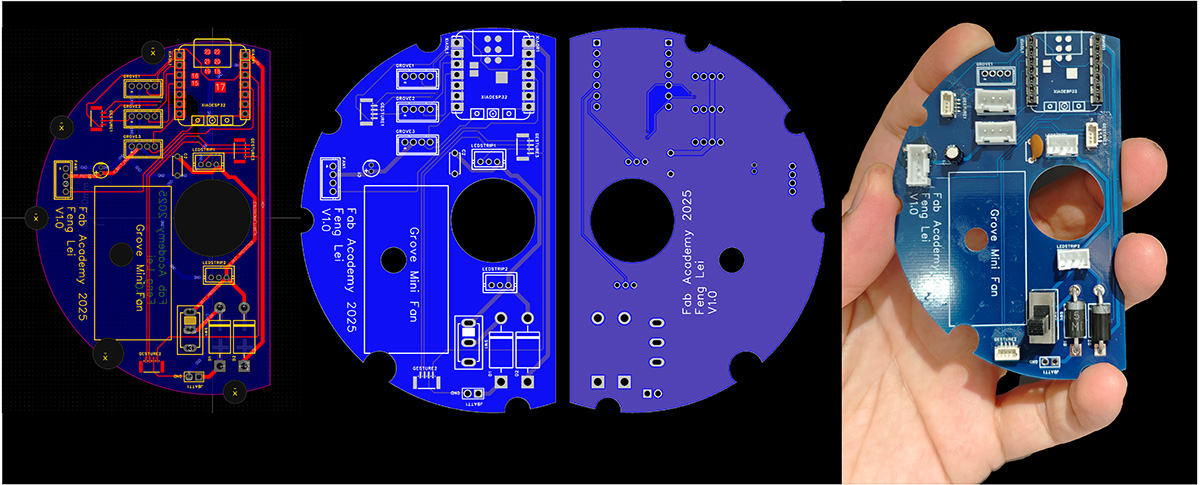

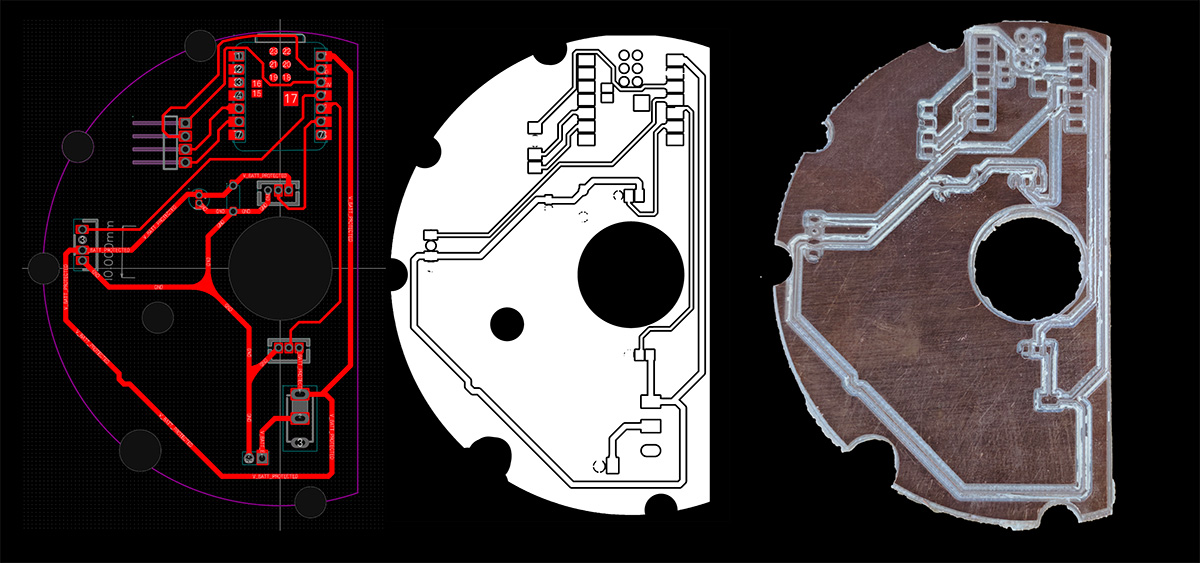

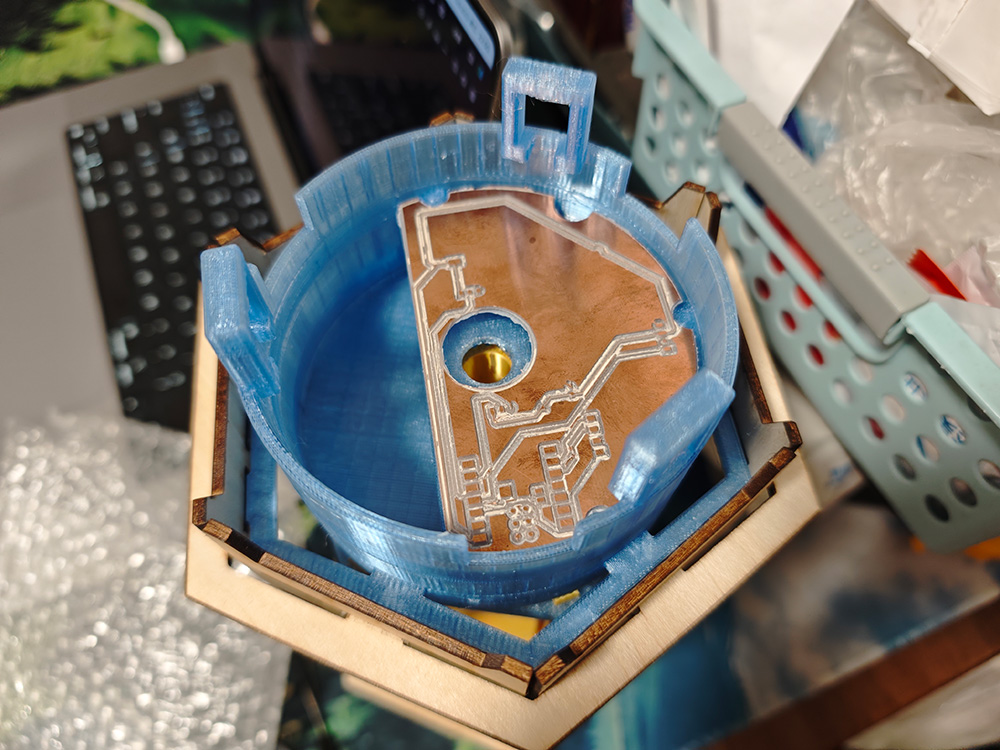

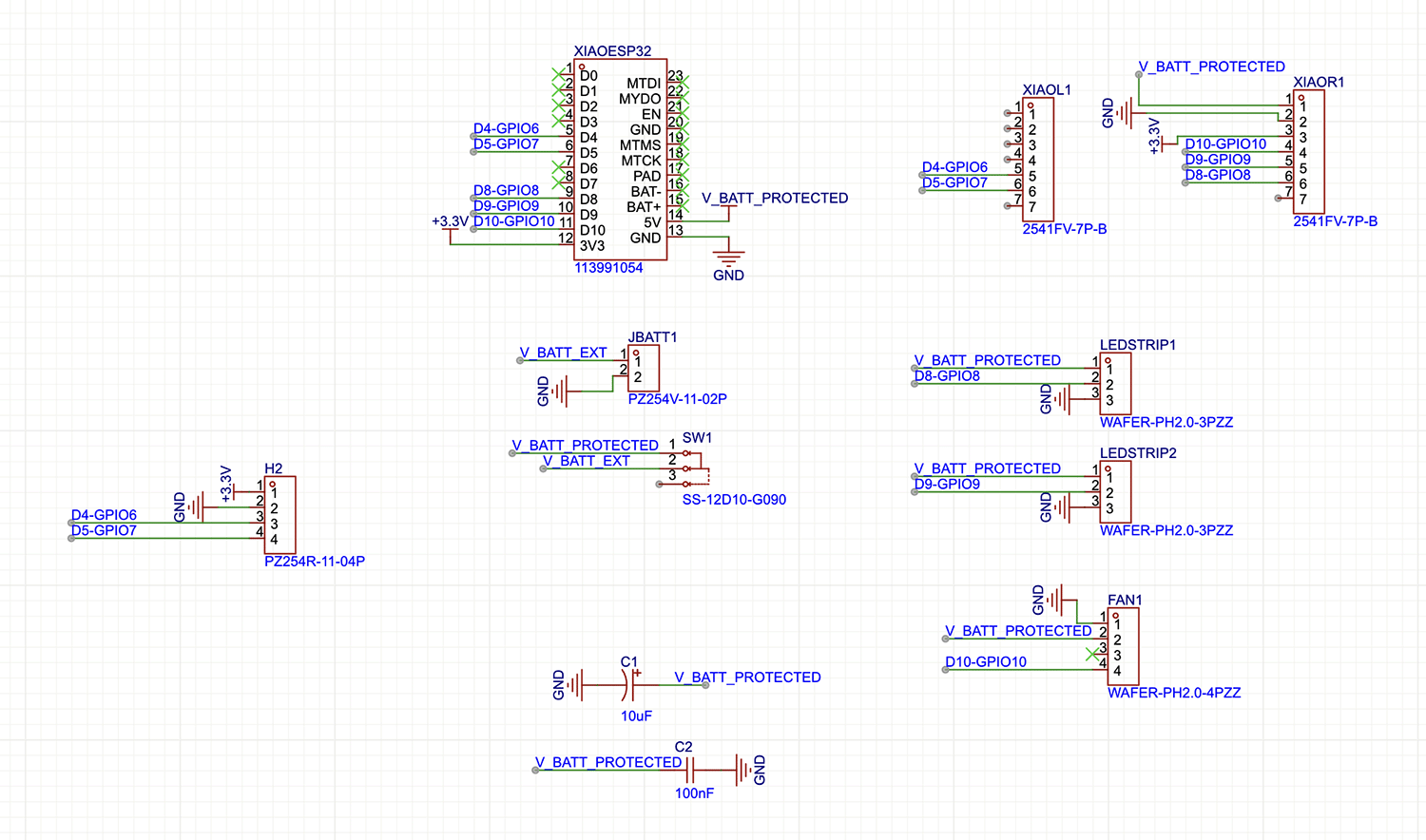

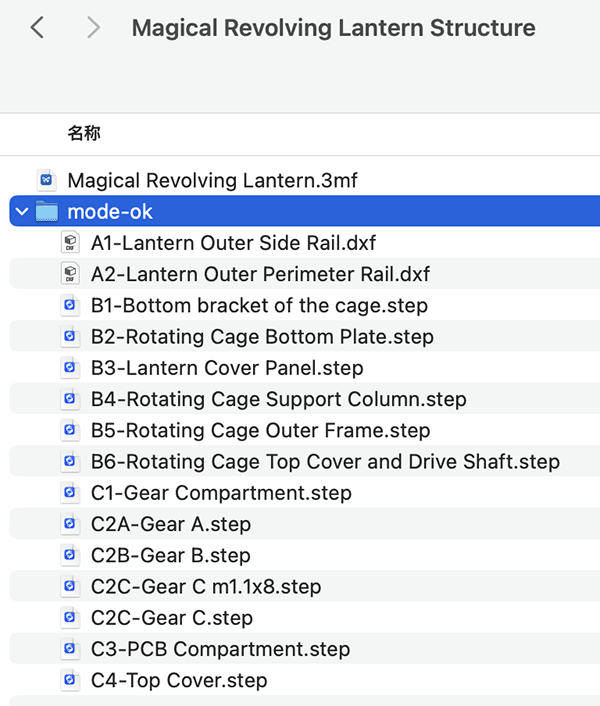

  • Circular PCB Design and Fabrication: Need to design and produce the new circular PCB that supports all required interfaces
  • Multi-directional Gesture Recognition: Implementation of the three parallel APDS-9960 sensors to achieve omnidirectional gesture control
  • RGB Light Strip Integration: Installation and programming of the dual RGB light strips for 360° visual effects
  • Motor Control System: Integration of the Grove Mini Fan driver with the XIAO ESP32C3 for precise motor speed control

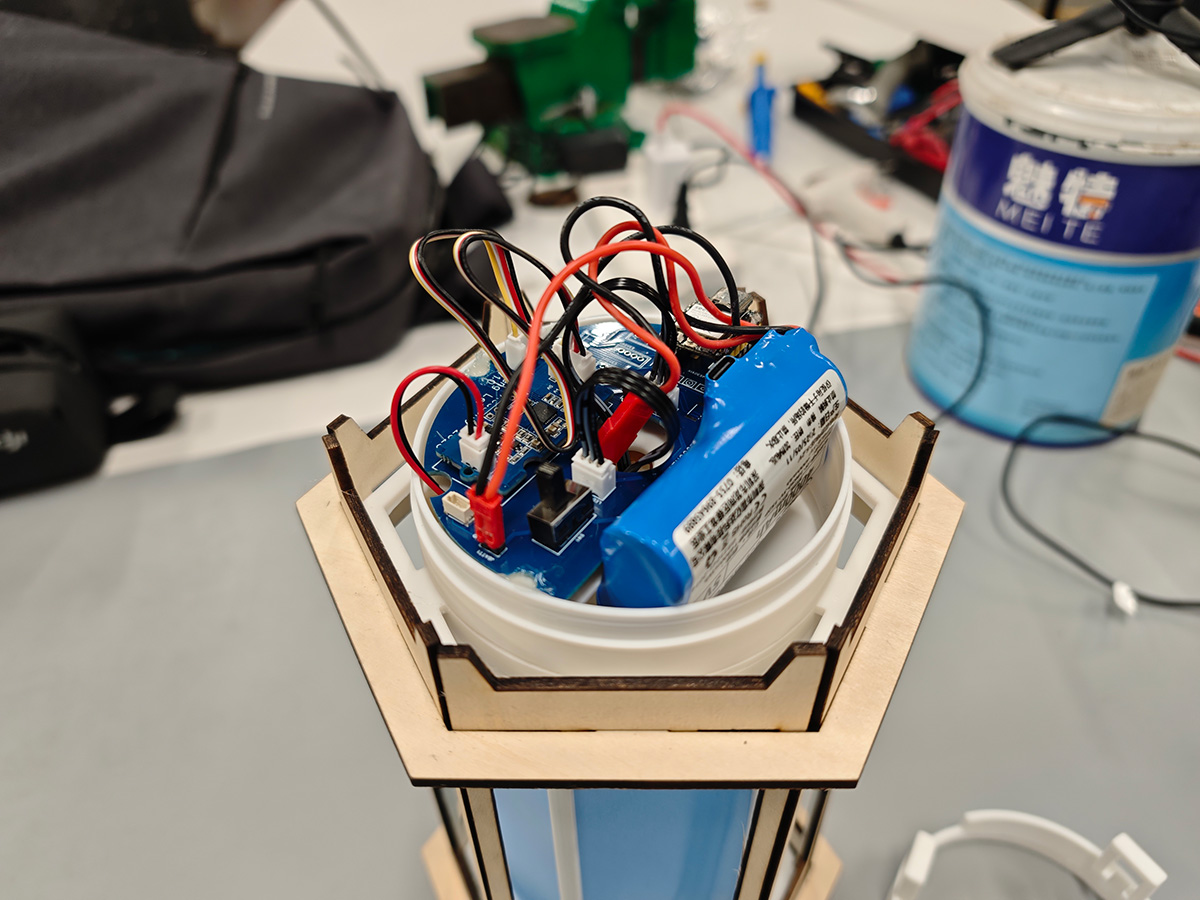

  • WiFi and MQTT Communication: Development of the wireless communication system for multi-lantern synchronization
  • Final Assembly and Testing: Integration of all subsystems into a cohesive product and conducting thorough testing
  • Power Management System: Implementation of the rechargeable battery system with efficient power management (optional, will attempt if time permits)

Next Steps

  1. PCB Design and Manufacturing (5-7 days):
    • Complete the circular PCB schematic design
    • Design PCB layout and routing
    • Manufacture the PCB and assemble components
    • Test all interfaces and connections
  2. Component Integration (2-3 days):
    • Connect and test the gesture sensors
    • Install and program the RGB light strips
    • Integrate the motor system
    • Connect and test the battery system
  3. Software Development (2-3 days):
    • Develop firmware for multi-sensor processing
    • Implement RGB and motor control logic
    • Set up WiFi and MQTT communication
    • Create gesture control and device synchronization features
  4. Mechanical Integration (5-7 days):
    • Finalize the transmission mechanism
    • Adapt the lantern shell for PCB and battery housing
    • Complete final assembly and balance adjustments
    • Conduct comprehensive testing according to the test plan

Project Documentation Plan

The final project documentation will include the following sections:

  1. Project Overview
    • Project background and sources of inspiration
    • Function introduction and technical features
    • Application scenarios and value
  2. Design Process
    • Mechanical structure design
    • Electronic system design
    • Software system design
    • Design iterations and improvements
  3. Production Process
    • Materials and components list
    • Detailed production steps
    • Encountered problems and solutions
  4. Results Presentation
    • Final product showcase
    • Function demonstration videos
    • User guide
  5. Reflection and Summary
    • Project outcome evaluation
    • Learning gains and experiences
    • Future improvement directions
    • Related source files

References and Resources
